By Pepper Parr
August 21st, 2020
BURLINGTON, ON
Those who pay attention to what happens in the way of development in the city, most notably in the Downtown Core, have always had their concerns about the quality of the leadership of the department and the high level of staff turnover and the changes at the top.
Jamie Tellier, one of the nicest people in city hall, currently the Interim Director of Community Planning, serves as pretty close to a right hand to Director of Planning Heather MacDonald.
Tellier knows where all the bones are buried, not that he is likely to tell you exactly where they are but he knows.
Thus when it comes to taking a look at the organizational set up of the department Tellier is probably the best person to explain how it is set up and then opine on how it might be changed.
The heavy lifting on how the department evolves will come out of the mind of City Manager Tim Commisso who also knows where the bones were placed.
In a report discussed at Council last week we got a look at just where the problems lie and some of the potential changes that could be made.
Tellier set out the size of the workload and the legislative documents that planners have to comply with – he added that those documents are dynamic – they are not static.
The size of the task ahead of the Planning department is daunting. Tellier explained that planning in an infill context is complex.
He added that there are approximately 50 Active Major Developments, about 7000 residential units, 40 Tall/Mid-rise buildings, 30 Major Development Pre-consultations.
There are 11 Appeals for Major Developments and 31 Appeals to the Interim Control ByLaw (ICBL).
Pre-building permit application volumes are up more than 50% from this time last year.
Add to the work load there is the adopted Official Plan that is undergoing a Scoped Review focused on the downtown, a comprehensive Zoning By-law Review, Housing Strategy, Region MCR, Core Commitment, Various Urban Design Guidelines and Cultural Heritage.

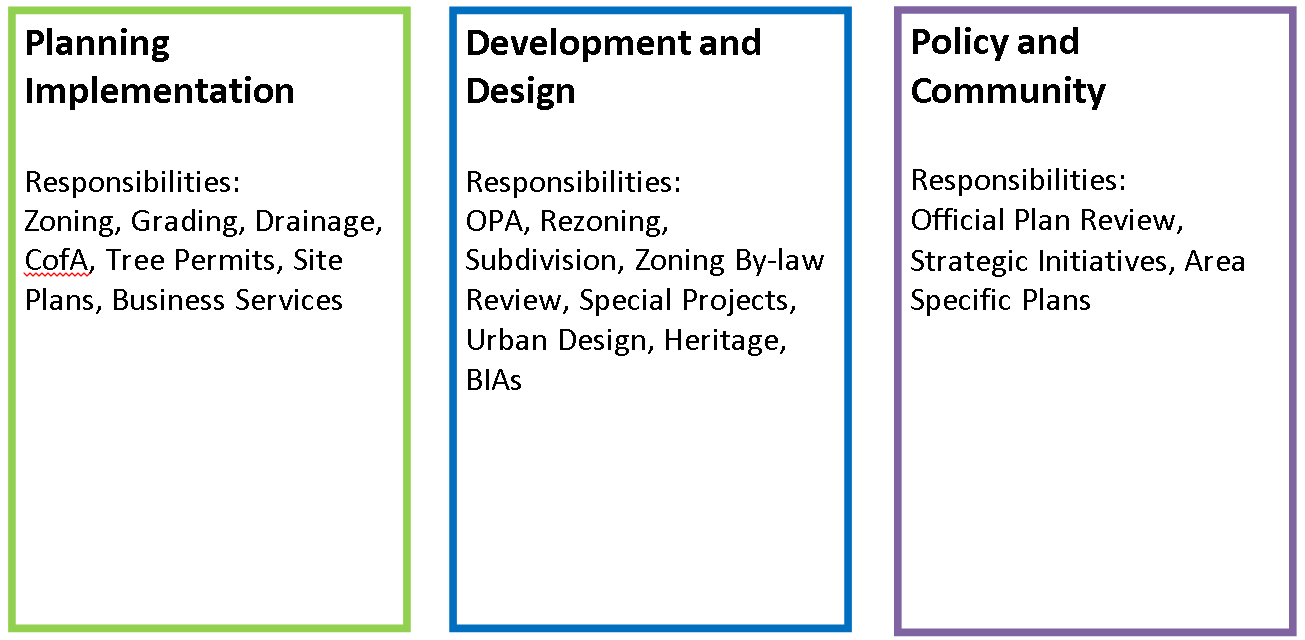

Here is the current organization of the department.
Tellier explained that the department is a mess and cannot keep up with the demand. Increased staff effort in processing complex infill development applications means getting some help.
Full cost recovery for development planning fees is needed to support fiscal. The last development application fee review was completed in 2012. An updated “Effort-Based” development application fee review is badly needed. Council wanted to know why it wasn’t kept up to date. “We just didn’t have the time” explained Tellier.
He added that only development-related HR costs are recoverable from development applications. Non development-related HR costs such as Policy are recovered through the tax base.
Tellier said Council should assume approximately 60-70% Community Planning HR costs are recovered by development application fees and 30-40% recovered through the tax base.

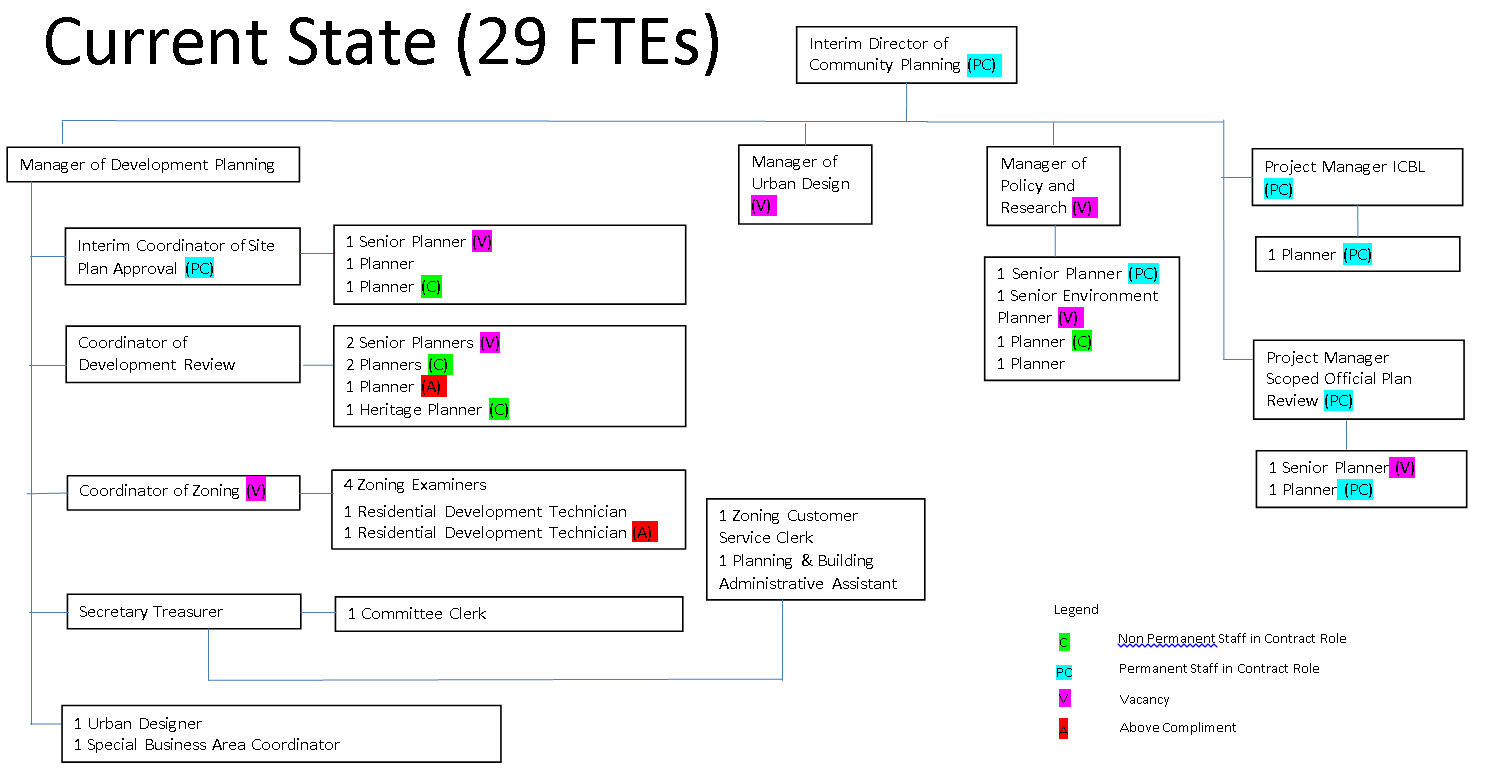

The change from what exists in the way of an organizational structure and what Tellier believes is needed looks like this:
The department isn’t going to suddenly jump from what it is to what they believe is needed. It will have to be phased in.
The phasing will probably cover two budget cycles – taking this to past the end of the current council term.

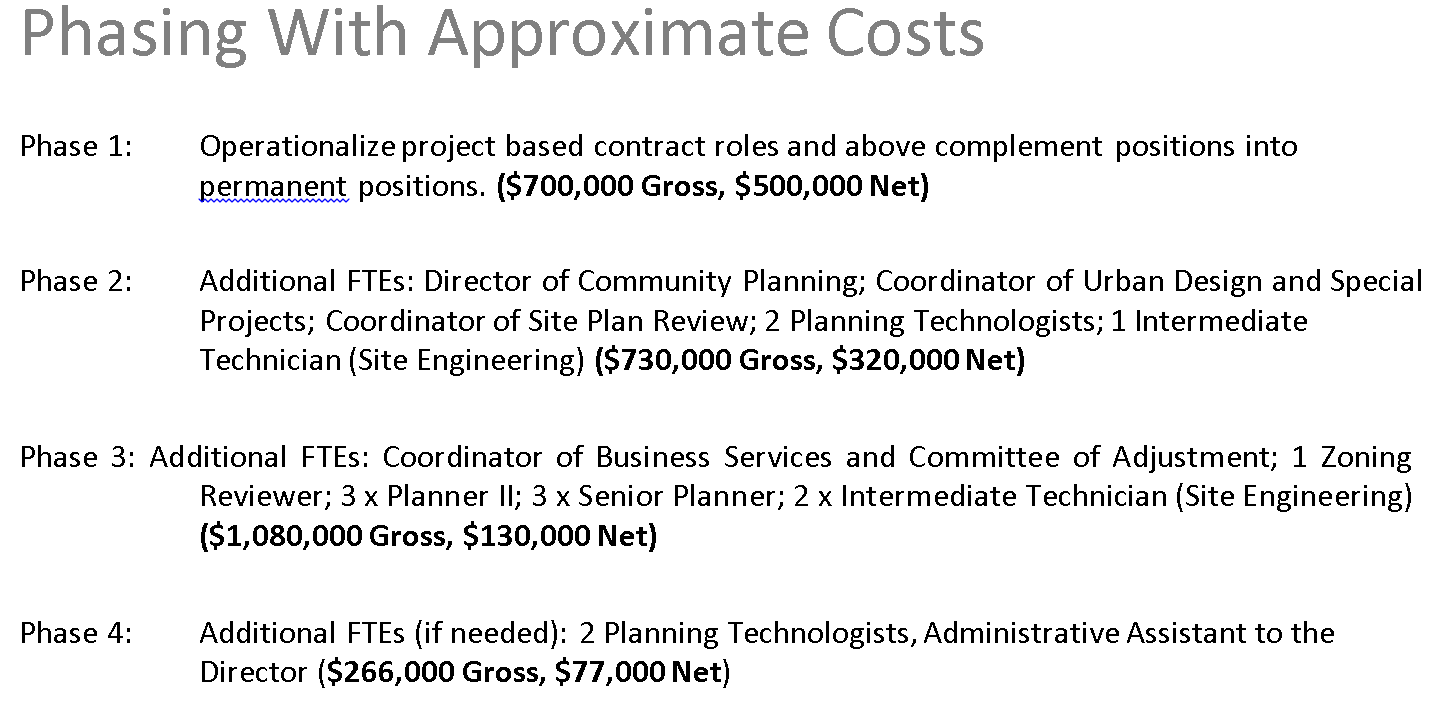

The phasing and the benefits that will be experienced is set out below:
The outline of what is needed will probably get tweaked; what isn’t in doubt is the organization structure planning staff have had to work under while the city moved into a dizzying level of growth that they were not prepared to cope with.
Does the plan that Tellier presented solve the problem? He has the total support of Executive Planning Director and the City Manager. Council is going to have to chew on this one for awhile.
