Councillor Taylor likes the attention rural Burlington is now getting - residents aren't all that certain there is a benefit for them in all that attention

News 100 greenBy Pepper Parr

May 4, 2016

BURLINGTON, ON

I think most of the people who attended John Taylor’s constituency meeting at the Conservation Authority office on Britannia Road Monday evening expected to get a really clear explanation as to why the city decided not to go forward with the Mt Nemo study that started back in 2013.

There was an explanation – sort of. A combination of the things the study didn’t have going for it and the amount of money it was going to require (that is more speculation than fact – no one was able to say during the meeting just how much had been spent).

Mary Lou Tanner

Director of Planning Mary Lou Tanner – joined the city six months ago.

The explanations – three city staff people took a crack at it – was that they were going to go back to all the feedback that came from the Rural Summit in 2013. That event certainly produced a lot of comment – what disturbs is that neither the current planner nor senior policy planner Don Campbell were in place at city hall when that meeting was held.

Staff would have collected a lot of notes and there were probably a number of briefing papers prepared but there is nothing like being in the room to get a sense of what really happened.

It sounded as if the planning people – with a lot of input from the city manager – had decided that everything should come under the Strategic Plan umbrella. The Mt Nemo study didn’t appear to do that – so it got the hook.

Mt Nemo Rural-summit-map-682x1024

Rural Burlington residents look over a large aerial photograph of their part of the city and wonder how ling it is going to remain the way it is.

The Official Plan Review – that is now on again – is to comply with the Strategic Plan. A significant statement in that Strategic Plan is to manage and protect our rural environment. Manage it for who and protect it from what was a question residents asked on several occasions.

The city set out what had been done when the Heritage Character of the Mt Nemo Plateau was being studied.

1. Preliminary Study of the Heritage Character of the Mount Nemo Plateau
2. Heritage Conservation District Study

Assessed character and heritage.

Identified options for the long-term conservation and enhancement of the character and heritage.

Recommended further study.

Key Finding
‘…a distinct historical community represented by a range of heritage features and elements…bounded in such a clear physical manner…the study area can be identified as an organically evolved, continuous Cultural Heritage Landscape’

What is a Cultural Heritage Landscape? A collection of related built form, landscape, vegetation, archaeological resources and other elements that have heritage value.

What is a Heritage Conservation District? What would it do for people within the district. Most felt that all it really was – was another layer of regulation.

Geographically defined area
Protects from unsympathetic alterations
Applies to a collection of historic buildings, streetscapes, landscapes
Areas are referred to as “designated”
Tool to manage change in accordance with a set of Guidelines (Heritage Conservation District Plan)
Plans are unique and is developed with the community

Chronology:

June 2013 Council direction to undertake preliminary research
January 2014 Preliminary assessment presented to Committee
January 2014 Council direction to consult with public
February 2014 Public consultation event shared findings of the preliminary assessment
 April2014 Public consultation event to discuss the preliminary study, proposed next steps in starting a Heritage Conservation District Study
May 2014 Council Decision: To proceed with the Heritage Conservation District Study
October 2014 MMM Group retained to complete the HCD study
February  2015 Public meeting to present research and field work completed by MMM Group to date
February 2015 Council direction: Place Official Plan Review reports and Mount Nemo on hold pending start of the new city manager and Strategic Plan.
January  2016 Official Plan Review restarted.

Between February of 2015 and January of 2016 city council was working its way from what started out as a four year Strategic Plan to a document that covers the next forty years.

Rural Burlington residents wanted to know what the benefit was for them from this new approach. The comment was that while downtown grows “up” – the result of intensification, the rest of Burlington would grow outwards which would have more people using the rural part of the city.

It was about 15 months ago that rural Burlington began the discusion about what it wanted to be. Some things were clear - others not as clear. The early draft of a vision got put on a huge board and for the most part the communuty liked the look of what they had said to each other.

The early draft of a vision got put on a huge board and for the most part the community liked the look of what they had said to each other.

Most residents resented the layers of regulation they had to deal with: Conservation Halton, Niagara Escarpment Commission, the Region and then the city. It was too much.

Pros and cons

Once the planners had determined what the pros and cons were – the decision was pretty easy to make.

The planning department had two new staffers: a new director and a senior policy advisor – they reviewed everything they had and came to the conclusion that a Conservation Heritage District wasn’t needed, didn’t fit in all that well with the Strategic plan and certainly wasn’t’ what the residents wanted. Their graphic setting out the pros and the cons was enough to convince the politicians.

graphic02Staff saw the killing of the Heritage Conservation Districts as an opportunity to refocus; build on community feedback received to date and find the local vision that they believed came out of the Rural Summit in 2013.

The air park didn’t get as much as a mention.

Part two will follow.

Return to the Front page

Is the Adi Nautique development downtown been revised to 18 storeys? Look at the offer carefully.

News 100 redBy Pepper Parr

April 28, 2016

BURLINGTON, ON

It’s bold – its brassy and all part of the sales pitch.

Developers like to be able to say – xx% sold – and the closer that xx is to 70 – the better.

Nautique ad sent out

$310,000 + will get you a splendid view of the Escarpment.

Development projects have to be sold – and this latest move by Adi Development Group is certainly a sales pitch that catches the eye.

ADI Nautique detailed sketch

Days before their application to the Ontario Municipal Board AdI Development announced that they had acquired the lot shown as 380 Martha – which changed significantly the size of the property they wanted to build on. Adi is currently in talks with the city’s planning department.

In Burlington the objective is to get in on a property as early as you can – and this pitch makes it a little easier. They are offering units on the north side of their proposed 26 storey tower at the corner of Martha and Lakeshore Road.

The following is an electronic message forwarded to us by a regular reader:

New prices just announced for escarpment facing suites at Nautique Lakefront Residences Downtown Burlington!

Prices start as low as $309,990 (1 parking space included).
The suites at Nautique Lakefront Residences have been designed by award-winning Cecconi Simone and feature open-concept layouts to maximize living space. Contemporary European custom-designed kitchen featuring corian countertop and backsplash with five-piece euro-style appliance package along with in-suite white stacked washer and dryer. Spacious lakeview terraces & balconies.

The building features two floors of amenities space with a 6th floor outdoor terrace and 18th floor sky lounge overlooking the lake. Outdoor swimming pool, whirlpool, bbq’s, party room, dining room, library, private lounge, fitness centre, indoor/outdoor yoga studio & more.

Don’t miss this fantastic opportunity to invest! Inventory won’t last long!

SPECIAL EXTENDED DEPOSIT STRUCTURE
$5,000 on Signing
Balance of 5% in 30 Days
5% in 120 Days
5% in 370 Days
5% in 540 Days

PARKING: 1 Parking Spot Included In The Purchase Price
OCCUPANCY: November 2018

Give Noman Khan, Broker, Loyalty Real Estate, Brokerage
905.330.4077 – vipcondosales@gmail.com

Some questions arise out of this announcement. Does the 18th floor sky lounge overlooking the lake suggest that the building will top off at 18 stories?

Nautique ADI rendering - sparse

Adi is aggressively marketing the condominiums on the north (Escarpment side) of the building.

Adi is currently in talks with the Burlington Planning department to see if they can come to terms on a site configuration that will get them past one of the tougher OMB Board members who has given then some time to see what the city thinks of the addition of an additional piece of land that adds significantly to the size of the footprint they have to work with.

The city’s planners never say a word about how development talks are going – it will be Adi that does all the talking – and this most recent release, which they sent out to selected people, suggests they have run something by the planners and think they might have some buy in.

Adi fence - from lkeshore looking nth

A portion of the property that Adi Development group wants to put a 26 storey condominium on – he size of the foot print they want to build on has been revised

After the decision the OMB handed down on the appeal Councillor Jack Dennison made to the Board to reverse the decision made by the Burlington Committee of Adjustment that opposed his request to sever his Lakeshore Road property. Many in Burlington shuddered at that decision and wonder what the city’s chances are going to be with the Adi situation is that before them.

We know nothing about the OMB member who heard the Dennison appeal – but we can tell you that Susan Schiller who is hearing the Adi application is not going to be an easy one for anyone.

Susan Schiller heard the application Nelson Quarry made for a permit to expand the quarry they were mining in rural Burlington. The application was denied.

Watch this one carefully. Asking for a different OMB member to hear the ADI application is something that can be expected: such an application would be about a “perceived bias” on the part of the member.

Business is business and you do what you have to do.

Return to the Front page

As much as three years of citizens complaints about construction disruption while the smartest development the city has seen in 25 years gets underway on Lakeshore Road.

News 100 blueBy Pepper Parr

April 12, 2016

BURLINGTON, ON

This isn’t the time of year for people to be out on the streets all that much – it’s still a little chilly.

For those who do venture to the edge of the lake and happen to wander east of the Waterfront hotel – they find themselves entering the early stages of a construction zone.
That lot that used to be home to the Riviera is now just mud with pieces of equipment scattered around the site.

Bridgewater - drill - bore hole

It could be taken for some kind o armament – but it is a drill that bores into the ground.

Fencing is in place and those “must wear a hard hat” signs are beginning to go up. Earlier in the week there was a tall – maybe three storey’s high – rig on the property. Bore holes were being drilled.

Bruno Kresina, the construction project manager, wasn’t on hand to explain what was going on.

The piece of land was home to the sales office – that was torn down a couple of weeks ago. The large six foot by six foot scale model of the Bridgewater project was put in storage – it will show up again when the new sales office is opened.

For a while the use of office space in the downtown core east of Brant was close to a game of musical chairs. Mayrose Tyco owners of the five storey tower on the north edge of the Elizabeth Street parking as well as the owners of the Bridgewater development, had rented space to the Joseph Brant Hospital Foundation. They were set up on the ground floor of the building while the parking lot at the Joseph Brant hospital underwent a massive re-development re-build that is costing the taxpayers $60 million – with the hospital foundation raising a second $60 million.

Bridgewater Aerial-rendering-1024x758

A drawing setting out where the different buildings will b situated and the open space for public access.

With the hospital foundation out of the space, Jeff Paikin and his New Horizons Development group can move their sales offices into the space. Not they need all that much of a sales office space – they are said to be past the 70% sold point – and that must be true because the bankers don’t release the cash until sales are at that magic 70% level.
And so now the construction begins.

Details

This is what the south side of Lakeshore is going to look like sometime in 2018 – there will be public access to the lake in between the hotel on the right and the condominium of the left. It won’t be a very wide opening.

It’s a complex set up. The development was approved by city council in 1995 – it was to be a “legacy” project that had been in the minds of the Mayrose Tyco people before 1985. There were some land swaps that squared the assembled land – and a couple of close calls when Conservation Halton, who had grandfathered the development a long time ago but were beginning to get impatient.

Mayrose Tyco brought in the Mady Group to build what was to be a 22 storey condominium and a seven storey condominium plus a seven storey hotel that edged up to eight storeys.

The first hotel was to be a Delta – that got upgraded to a Marriott – which is some distance from the old Riviera motel.

Mady ran into financial problems – Mayrose Tyco took them off the building of the development and asked Paikin if he would take on the construction.
Paikin had already bought a unit in the seven story condominium – he was now going to build his new home.

Bridgewater - road alignment Apr 12-16

You are looking at what is going to be pretty close to the new street – sidewalk alignment on the south side of Lakeshore immediately east of Elizabeth street.

LogoIt will be a couple of years before the any moving vans arrive – the residents of the city have a couple of years to complain about the construction disruptions.

When it is completed – the waterfront will be a much different place.

Save the news feedThe construction of the pier and now this luxury level hotel and some very high end condominiums, which will be described as the finest buildings to live in the GTA. Better than Oakville?

Return to the Front page

Strategically city council apparently knows what it plans to do for the next 25 years - really? Strategic Plan approved.

element_strategic_planBy Pepper Parr

April 12, 2016

BURLINGTON, ON

It was more than a year in the making during which it went from the traditional Burlington four year plan that got expanded to a 25 year plan that added $200,000 to the city’s budget, presumably to maintain the plan or do some of the numerous promises in the document.

Council was proud as punch with the achievement.

It was described as the product of public engagement and a plan the city believes captures the priorities of the city’s residents and community leaders. Input was gathered from business groups, community groups, staff and residents. The city held workshops in late 2015 and early 2016 to test the draft with the community, making 176 changes to get to the final version.

Burlington aerial

A City that Grows, A City that Moves, A Healthy and Greener City and An Engaging City – call it home – with a plan for the next 25 years.

In the media release the city said: The strategic plan includes four strategic directions:
A City that Grows
The City of Burlington attracts talent, good jobs and economic opportunity while having achieved intensification and a balanced, targeted population growth for youth, families, newcomers and seniors.
A City that Moves
People and goods move through the city more efficiently and safely. A variety of convenient, affordable and green forms of transportation that align with regional patterns are the norm. Walkability within new/transitioning neighbourhoods and the downtown are a reality.
A Healthy and Greener City
The City of Burlington is a leader in the stewardship of the environment while encouraging healthy lifestyles.
An Engaging City
Community members are engaged, empowered, welcomed and well-served by their city. Culture and community activities thrive, creating a positive sense of place, inclusivity and community.

James Ridge - looking right

City manager James Ridge – once he got his teeth into it – the Strategic Plan became his baby – now he has to deliver on it.

“The new plan is a blueprint for city-building,” said City Manager James Ridge. “This is a bold, ambitious multi-year plan that we will deliver in partnership with the community.”

The media releases are intended to put the city’s spin on an event. What was actually said during the Monday evening council meeting wasn’t quite the same

There was serious concern over the lack of any prioritization and where the money was going to come from to pay for all the plans.

Mayor Rick Goldring said: “With the strategic plan now approved, the city will work with its leadership team to add detail to each strategic direction, including completing the city’s Official Plan and Transportation and Transit Master Plan.

“I look forward to working with council, staff, our residents and businesses to get started on initiatives across Burlington outlined in our strategic plan.”

The city will continue to report back to the community on the progress of the plan, including through issues of City Talk, and through advertising and social media as well as updates to City Council.

The intention is to continually review, refine and update of the Plan quarterly.

And of course the Gazette is going to be there every step of the way. We were the only media organization that attended every one of the Strategic Plan meetings and have an insight that will inform what we write.

During the creation of the Strategic Plan Mayor Goldring made a trip to China – there was never a report on that trip – what it cost and what was achieved.

Strategic Plan Workbook

In the beginning – when work on the developing of a Strategic Plan started it was going to be a four year plan – it grew.

There has not been a report on how much was spent on the creation of the report – going from a four year plan to a 25 year plan certainly added to the cost.

Also, there doesn’t appear to be a recorded vote or any discussion on the decision to move from a four year time frame to a 25 year time frame.

The Strategic Plan will be on the city’s web site – as soon as we know exactly where it is we will advise you.

Return to the Front page

Is a decision on the city's court case asking a judge to compel the Air Park to file a site plan and remove the illegal land fill due soon?

News 100 redBy Staff

April 4, 2016

BURLINGTON, ON

April may turn out to be a very good month for the city of Burlington.

Airpark aerial used by the city

Will a Judge order the Air Park corporation to remove the tonnes of illegal land fill from the land and file a site plan with the city – before the end of the month?

We are advised that the Justices that hear court cases are close to releasing a decision on the application the city made for a Judge to compel the Burlington Air Park to comply with the city bylaw requiring the submission of a site plan for the air park property and also remove the tonnes of illegal land fill on the 200 acre piece of property.

The court case was held last November, in one of the smallest t court rooms in the Milton court house where some 20 people crammed into space that might have held 10 comfortably.

The Gazette is advised that a member of the city’s legal staff advised council that a Judge at the Court House advised the city that Justice Gibson anticipates he will be in a position to release his decision by April 30th.

This will be a ground breaking decision which, given the way the Air Park corporation has handled precious decision that went against them in the past, will file an appeal.

Because of the significance of this case to the municipal community across Canada – this case could make it all the way to the Supreme Court of Canada.

Return to the Front page

Parking Standards to get a review - first time in 30 years - we need to do the homework, think hard about the problems and the solutions.

SwP thumbnail graphicBy Pepper Parr

March 28, 2016

BURLINGTON, ON

The city is bedeviled with what to do about parking – there are those who feel a parking spot is supposed to open up for them in exactly the place they want to put their vehicle. Many seem blind to the impact their vehicles have on the environment and even though they have more disposable income than they could possibly spend they howl over the cost of parking.

Mapleview Mall - parking north east side

There are times when you can’t get a parking spot at the Mapleview Mall where there are acres of parking space. Is there a solution? We need one.

The city has two malls –one with fields of parking that are covered in asphalt that creates significant storm water management problems. The city owns more than half a dozen parking lots plus a multi-storey tower downtown that is rarely full. Developers are putting up structures for people who may well not require the amount of space the city rules require them to build – but the rules are the rules.

Buzz-on-Elizabeth-1024x682

Could we begin freeing up some space and creating spots for just these little guys?

Many of the cars on the road these days are not as big – two could fit in the parking spots now underground but the rules don’t permit much flexibility.

The city has thousands of homes with garages – but residents complain about parking space because their garage is used as storage or a workshop.

The city does have some issues with parking – the biggest of which is public attitude.

The department of transportation is holding an Open House to gather public opinion as they work towards a major review of what the parking standards should be for the city.

Vito Tolone, the recently appointed Director of Transportation, has been around parking most of his municipal career – he knows what he is talking about. He does get a little excited at times during presentations but if you listen to him and pay attention to what he has to say – you will find he is usually right.

This project he is overseeing with the aid of the IBI Group who are serving as consultants to the city is to develop parking standards that:

• Are clear, defendable, and based on sound technical analysis;
• Recognize differences in existing land use and support the envisioned urban structure;
• Encourage transportation alternatives to the personal automobile, where available;
• Support efficient forms of development in terms of costs and land requirements; and
• Balance the needs and concerns of a diverse set of stakeholders including City staff, (who happen to get free parking for their cars), developers, businesses, ratepayer groups, TDM organizations, and the general public.

Burlington City Council Group

This is the crew that is going to have to look at the staff report and then stand up and do the best thing for the people that put them in office – that will call for them to work ad a team – not something that is seen very often.

Lessons learned in previous studies point to the following key success factors: There has to be support at a very high level – city Councillors have to be behind any changes.

There has to be a willingness to accept at least a degree of change, which amount to some political courage and real leadership. Burlington has always been a little short on political courage.

There has to be a balance of technical analysis, best practices and policy guidance. That policy guidance comes from staff based on the data they collect and the advice they get from the consultants the hire.

Potential Challenges include: Collecting data for wide range of uses; obtaining data from private residential properties; developer input (the developers have to be responsible and pay at least some attention to the greater good and not just their bottom line.

There may be a disconnect between the ideal future standards and current behavior (truer words have not been written. Finally, phasing in parking standards is difficult.

Key Issues for Study

• Parking issues differ across user groups and land uses
• Balancing the needs and concerns of a diverse group of stakeholders is a concern
• The city anticipates parking pressure from downtown redevelopment.
• The unclear future of emerging trends in transportation technology and their impacts on parking requirements is not something easily known.
The consultation process is:
• To gain an understanding of the issues that residents, business owners, developers, etc. face in regard to parking and parking standards;
• To gain an understanding of the potential effectiveness of changes to parking standards in making more efficient use of parking, supporting transit-oriented development, and other policy objectives; and
• To gain buy-in from the business and development community, ratepayers, and other interest groups on proposed parking standards.

With the Strategic Plan about to get a blessing from city council staff will begin to fit the role transportation is going to play in the way Burlington will get grown during the next 25 years.

Work on the Official Plan can go forward with more precision now that the Strategic Plan is in place. The Transportation Master Plan will get re-shaped and not exist as a plan that does not fit in tightly with everything else. This is going to be a new experience for the bureaucrats – city manager James Ridge has made it clear that his approach to managing the growth of the city is to always be looking at the complete picture.

Station West

It’s an empty field right now – in a very short period of time it will be a very busy construction site with stacked townhouses and apartment/condo towers – with not that much in the way of public space. All being done legally.

The city has come to the conclusion that it will have a number of mobility hubs and appear to be being forced by a developer in the west end to go with the Aldershot GO station as the first hub – even though for the sake of the city – Aldershot may not make the most sense.

Station West A sign

The Station West development yards from the Aldershot GO station is being actively marketed by the Adi Development group.

The problem is a developer is racing ahead with plans that the city has to climb on board with or get left behind. Quite how Burlington got itself in this bind is going to take some analysis – and if there are planning tools that can give the city more leverage – someone better find then and learn how to use them quickly.

Wednesday night the public gets a chance to make its views known. We need to do this right the first time – once decisions are made – there is no going back. We haven’t done all that well with transportation issues in the past.

Return to the Front page

Strategic plan supporter gives the city a thumbs up for a document that took nine months to create. He no hopes that the arts get serious funding going forward.

element_strategic_planBy Pepper Parr

March 21, 2016

BURLINGTON, ON

Getting it - yellowIt was one of those déjà vu evenings for Trevor Copp as he stood at the podium during a Corporate and community Affairs Standing Committee meetings – this time, at least to some degree – thanking the city for beginning to come around to his point – first made about five years ago – that artists were beginning to be able to work in the city they live in.

we

Trevor Copp in conversation with Angela Paparizo, the city’s cultural manager.

Copp’s was delegating at the meeting which was hearing comments on the close to final draft of the 25 year Strategic Plan. The event was part love in and part dotting the i’s and crossing the t’s while council and staff commented on just how involved citizens had been in creating the document.

It isn’t an overly long document – 30 some odd pages and there isn’t much in the way of inspiring language in it – but it is at least understandable.

Frank McKeough, former Chief of Staff to MAyor Rick Goldring asked about how politicians can handle complex issues when voters tend not to be informed and don't have the background needed to arrive at decisions.

Frank McKeown, former Chief of Staff to Mayor Rick Goldring and now the Executive Director of the Economic Development Corporation supports the Strategic Pan – now wants th city to deliver on the document.

Frank McKeown, executive director of the Economic Development Corporation added that it was a solid plan – the challenge now was to executive on that plan – and that is the real challenge.

City manager James Ridge, sounding like an author on a promotional tour, threw out the phrase “blue print for city building” as if it was the title of a book and he wanted to be certain that people go it. We counted five occasion when the phrase was inserted into his comments.

Ridge set out some of the challenges the city faces and identified a number of places where things are going to get done differently. The Gazette comments on the Ridge remarks elsewhere.

Throughout the creation of the Strategic Plan – and it was a creation – they took more than nine months to complete the document – we don’t know the total cost yet – the word culture was sprinkled rough numerous pages.

Jim Riley, part of the arts collective in Burlington, made the point that the word art had been left out – and while it may seem petty, Riley had a point. “The arts change culture” he said. Most of council got his point which is something that would not have happened five years ago.

Riley went on to point to definitions of culture in both a UNESCO document and a Ministry of Culture document.

Many speak of the role the arts plays in local economies –and city manager Ridge tends to portray himself as “arts sensitive” – just how sensitive will become evident when we see how much he invests in the art community.

The city puts just shy of a million dollars into the Performing arts Centre and another just shy of a million into the Art Gallery of Burlington – but not much of that money finds it way into the pockets of the artists.

The city does have a cultural manager who has an assistant – but the city seems to have said that it isn’t going to put much in the way of dollars into the Culture Days event that takes place each fall.

Strategic Plan Workbook

What has traditionally been a document to guide a city council during its term of office – the 2015 Strategic Plan was changed to a long term vision document that covers a 25 year time frame.

Of all the issues that got covered during the debate Monday evening – culture got the most air time – but there wasn’t a word from either the Executive Directors of the Performing Arts Centre or the Art Gallery.

Trevor Copp might have to come back to a council meeting and prod a little more. Copp’s did say that he felt there was very good public participation in the creation of the plan

“You couldn’t go anywhere without seeing a notice of a public meeting about the Strategic Plan” he said.

There was far more public discussion about this plan than any other document the city has developed. Michelle Dwyer, who is on her way to city hall sainthood for her efforts to get the plan completed, mentioned that she saw dozens of people attend meetings with copies of draft of the plan printed out and marked up in their hands as they walked into meetings.

James Ridge

The Strategic Plan came out of a city administration run by city manager James Ridge – it is now his to deliver on.

JC Bourque + Ridge + Dwyer

KPMG consultant JC Bourne with city manager James Ridge and Michelle Dwyer – the woman said to have made the creation of the Strategic Plan possible.

City manager Ridge said that the Strategic Plan “would have never happened with Michelle work”.

In his  closing remarks Councillor Craven said that he supported the plan (he had few questions about the content) but thought it took far too long and that it could have been done at a weekend symposium without consultants.

That’s the way they do things in Aldershot where, as the ward 1 Councillor pointed out “the developers are ahead of the city with their proposals” – Station West – the stacked ton house development is pretty close to a done deal.

The strategic Plan will get some fine tuning in the next few days and get put before Council on the 11th of April. Then the really hard work begins – because all those people who turned up at the public meetings are going to hold this council and its administration accountable for what is set out in the document.

Return to the Front page

Another attempt to get a private tree bylaw in place - Mayor advocates a pilot study for Roseland.

SwP thumbnail graphicBy Pepper Parr

March 21, 2016

BURLINGTON, ON

The Mayor is going to make another attempt at getting a private tree bylaw passed by Council – we think.

In July 2013, the Development and Infrastructure Committee chose to receive and file an information report on a private tree by-law feasibility study. Council did not vote to see the creation of such a bylaw at that time.  . The dean of Council, John Taylor, summed it up when he said “the will is just not there”, the public just doesn’t want this” and try as they might BurlingtonGreen and Ward 2 Councillor Meed Ward, who pushed as hard as one can push, could not get this through the Development and Infrastructure Committee.   ” It is going to be very tough to get a private tree by law in this city” said Taylor

In a Notice of Motion that he filed for debate at the Development and Infrastructure the Mayor said that since the 2013 failure he “ continues to hear requests for a private tree by-law in Burlington. Most recently, this came from members of the Roseland community as part of the Character Area Study process.

mnbh

Many of the trees in Roseland are very old – replace trees have not been planted – at some point the residents of this community will deeply regret the loss of their tree canopy.

“Recognizing staff did not support a private tree by-law specific to the Roseland neighbourhood … I believe there is merit investigating a pilot private tree by-law to gauge its impact.

“I propose that a report on a pilot project with recommendations be drafted by staff, with considerations to such aspects as length of time, extent of regulations, performance measures, staff resources required, among others.

“There are several reasons I support a pilot project for a private tree by-law in Roseland. I believe our tree canopy is essential to the environmental and physical health of our city and its residents. As well, as one of the community’s oldest neighbourhoods, Roseland has a large number of mature trees that contribute to its character. Through the Character Study, many residents expressed a desire to maintain the tree canopy and the presence of the large, mature trees.

“The Roseland Tree Planting Initiative is a noteworthy endeavour started by interested community members.

Belvenia trees-1024x768

A truly spectacular tree canopy – most of the trees are on city owned property.

“This cooperative effort by city staff and residents in the community to proactively plant trees within the public rights-of-way in areas with a high percentage of mature trees, and raise awareness among homeowners about the importance of trees within the neighbourhood, demonstrates the value placed on trees and as such, is an appropriate neighbourhood to implement a pilot private tree by-law.”

The Mayor added that “There are many other neighbouring communities that have private tree by-laws, such as Oakville, Hamilton, Toronto and Brampton. Mississauga is currently working on establishing a private tree protection by-law.

He also said: “When drafting the by-law, it is important staff strike a balance between private property owners’ rights and the intent of preserving our tree canopy. The outcome of this pilot project will be valuable in determining the applicability of a private tree by-law in other neighbourhoods, and, potentially, a private tree by-law for the entire city.”

The motion that will get debated is:

Direct the Acting Director of Roads and Parks Maintenance to investigate the implementation of a pilot tree by-law for the Roseland neighbourhood, with a review of options including, but not limited to: length of time for pilot project, extent of regulations, budget and staffing requirements, and measures to evaluate success, and to include community consultation.

Direct the Acting Director of Roads and Parks Maintenance to report back to committee on June 21, 2016.

There is a critical word missing from the Direction – the word “private” isn’t in between the words pilot and tree. Is this a motion to create a bylaw restricting what people can do with trees that are on their private property?

Geese on Guelph Line and the apple trees

A beautiful collection of apple trees next to st. Christopher’s church on Guelph Line that were cut down because Canada geese were eating the apples and pooping on the roadway.

There have been a very sad story told about the man who cut down a 50 year old tree because he didn’t want to rake the leaves. A lovely collection of apple trees were cut down on the property next to St. Christopher’s Anglican church on Guelph Line because Canada geese were eating the apples and pooping all over a driveway used for the most car by just cars. There was a promise to plant new trees – two years and counting and still no new trees,

The environmentalists take the position that people do not own trees – that we are the stewards of a tree for the period of time we own the property on which the tree grows. Mayor Goldring has positioned himself as an environmentalist – he tends however not to walk his talk.

It will take some time for a shift in attitude to take place in this city. Changes in attitude take place when a society is educated – it is the leadership of a community that does the evangelizing.

The motion the Mayor has put forward isn’t going to get us very far – I would love to be proven wrong on this one.

Background links:

Council looks for every way out of a private tree bylaw.

The environmentalists lost the fight in 2013



Return to the Front page

Adi's downtown development will not get the approval it wants until sometime in 2017 - in the middle of the municipal election.

News 100 blueBy Pepper Parr

March 16th, 2016

BURLINGTON, ON

It isn’t a new application – it is a revised application and the final phase of the Ontario Municipal Board hearing of the now revised Adi Development Group application to put 26 storeys of condominium development at the corner of Martha and Lakeshore Road will not be heard until February 20th of 2017.

Meed Ward with Mayor Goldring: she is more comfortable with herself as a speaker.

Meed Ward with Mayor Goldring: expect the two of them to head to head in the 2018 municipal election in 2018. At least one of the issues is becoming clear.

Expect this to become a prime election issue in 2018 when ward 2 Councillor Meed Ward will run against current Mayor Rick Golding when the issue will be – what kind of a Burlington do we want?

A much more contrite Adi legal team did everything they could to ensure Chair Susan Schiller that they were going to do everything they could to ensure that there was public participation in the revised application.

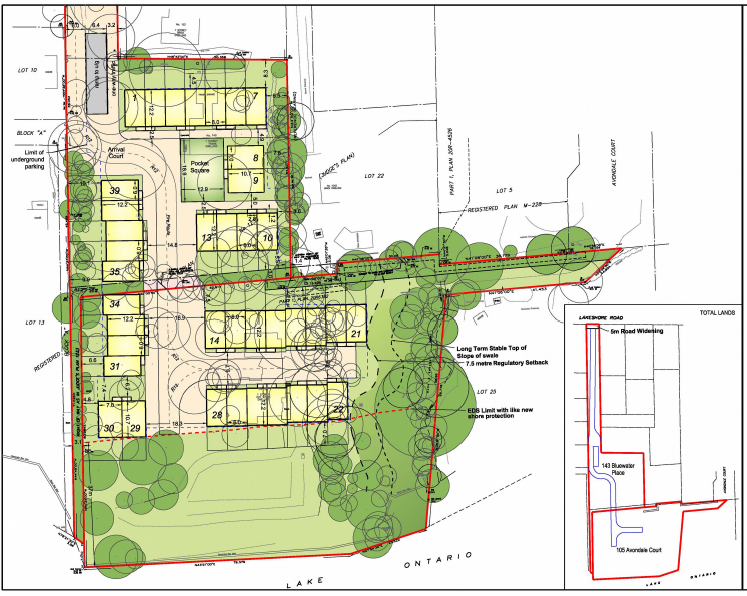

Nautique ADI rendering - sparse

The next rendering of Nautique will not look like this.

Hearings are as much about procedure as they are about the merits of an application. Because this is a revised application the city wants to know much more about just what the revision is all about – the only thing they know at this point is that Adi has purchased an adjacent piece of property and wants to merge it into what they already have. And what difference is that going to make to the shape and scope of the development – well those are the issues that are going to get discussed by the city’s planning department and the Adi architects before it gets back to the OMB.

What has been worked out is a schedule of events that has the Adi plans going to city council before they go back to the OMB hearing – which is a pretty interesting way to approach the problem.

Here is the lineup of events:

From now until the end of June Adi will have informal meetings with staff on what they have in mind with the new piece of land to the development.
At the end of June Adi formally amends the application.
There is then public notice of the of the revised application also at the end of June
Staff then does its review of the revised application and has until the end of September to get that done.
There is then a public meeting sometime in October
Late in October city council considers the revised application
There is then an OMB pre-hearing conference after the city council has had a chance to do whatever it wants to do. The date for this meeting will be late October early November.
Expert meeting reports are due November 28th
Witness statements are due December 12th
Participant statements are due January 6th
Reply statements are due January 16th
Visual evidence is due January 16th followed by a 10 day hearing that will start February 20th, 2017.

The city did have the right to ask that the development application be denied on the grounds that it was a new development which would have forced Adi to go back to square one and start all over.

This approach, which the public learned about this morning, is not bad – one might be gracious and call it pretty good.

Denise Baker, lead counsel for Adi promised everything but the kitchen sink as she explained the way Adi intended to proceed. One would have liked to see some of this willing to collaborate when the original application was filed rather than bully the city into an OMB hearing. They did have the right to do what they did – practice within the development community is to allow some grace time for development applications.

Adi - Saud and Tarif

Saud and Tariq Adi – it was heavy sledding for the twins at the OMB hearing.

One gets edgy when hearing the promises from an organization that has in the past flouted bylaws and put signage up along main traffic arteries and install large signs that were called hoardings at one point and then a fence on another – forcing the bylaw enforcement people to seek advice from the city’s solicitor before ordering Adi to comply with the bylaw.

ADI Nautique detailed sketch

Adi development added about 20% more land to the development they plan for the NW corner of Martha and Lakeshore Road.

The OMB hearing that began on Monday came to be because Adi was not prepared to give the city some additional time to vote on the application.

With Chair Schiller running the OMB hearing as it goes through its various stages – there will be no nonsense. Those at the media table in the hearing room remarked that she appeared more diligent when it came to the public interest than the city’s council.

Because some land has been added to the assembly the boundary demarcation for those who are permitted to ask to be part of the proceedings and have standing will become a little bigger and include people who were not included up until now.

Chair Schiller went out of her way to ensure that all the lawyers let people know they could make presentations.

Schiller noted there was a high degree of public interest in the hearings – television cameras arrived at city hall on both Monday and Wednesday.

It now becomes a waiting game. Adi will work at figuring out how much more they can add to the development – they are going to have to find a way to pay for that additional land.

Return to the Front page

And what has the Air Park been up to recently? City solicitor has a lot of questions.

airpark 100x100By Staff

March 16, 2015

BURLINGTON, ON

One never knows what is going to appear in the mail box.
The following was passed along to us – interesting.

March 11, 2016

Fax: 416-314-8452

Application Assessment Officer
Ministry of the Environment and Climate Change Operations Division
Environmental Approvals Access &
Service Integration Branch Application Verification Unit
135 St. Clair Avenue West, Floor 1 Toronto, Ontario M4V 1P5
E-mail: tina.dufresne@ontario.ca Ms. Tina Dufresne, District Manager
Halton-Peel District Office, Central Region
4145 North Service Road, Suite 300 Burlington, Ontario L7L 6A3

Dear Sir/Madam:
Subject: EBR Registry Number: 012-6693
Ministry Reference Number: 1720-A59NX4 Proponent: 2120901 Ontario Limited
Instrument Type: Environmental Compliance Approval – EPA Part 11.1-sewage
Location: 5432 Bell School Line, Burlington, Ontario

I am writing on behalf of the of the Corporation of the City of Burlington, in response to an application for a new Environmental Compliance Approval for 2120901 Ontario Limited posted to the EBR on February 4, 2016. For the reasons that follow, the City of Burlington is requesting that the application be returned to the proponent as incomplete for the reasons as will be set out below. In the alternative, the City is requesting that the time for the submission of comments be extended for an additional 60 days beyond the current deadline of March 20, 2016 to permit adequate time for consideration of the issues by Burlington City Council, and affected residents.

Background

The City of Burlington and the Burlington Airpark Inc. have been engaged in litigation for several years arising from an illegal fill operation taking place at the Burlington Airpark. The sewage works that are the subject of the application before you drain water from the landfill at the airport that is the subject of the litigation between the City and Airpark. The Airpark is located between Appleby Line and Bell School line, north of Highway 407, all of which is located in the northern rural area of Burlington.

Air Park dump truck

It was the dumping of landfill that resulted in neighbours calling the Gazette – we published the first stories on the problem which woke up people at city hall who began to look into the problem.

A fill operation on the Airpark property commenced in late 2007. The City of Burlington was never consulted about the fill operation or about any proposed expansion plans that the Airpark might have with respect to its operations. On or about March 2013, the City began receiving a significant number of complaints from new landowners in the vicinity of the Airpark. The nature of the complaints ranged from grading activities, drainage, noise, dust, traffic safety and about the possible effects of contaminants in the fill on drinking water. After having investigated these complaints, staff concluded that the Airpark was using its lands as a fill site in order to generate revenue and was not depositing fill to implement a planned and/or imminent expansion of its airport facilities.

As a result of its investigations, on May 3, 2013 the City issued an Order to Comply pursuant to its site alteration by-law by obtaining a permit for the ongoing fill operation. After the Airpark failed to comply, the City issued a Violation Notice under its by-law. Since that time, the City has been engaged in protracted litigation with the Airpark to bring the Airpark into compliance with the City’s by­ laws to address the off-site impacts caused by its fill operation.

Litigation Round 1

The Airpark brought a court application in July 2013 to prohibit the City from enforcing its Topsoil Preservation and Site Alteration By-law against the Airpark and the Airport. The City responded with a counter application seeking a declaration that the City’s Topsoil Preservation and Site Alteration By-law 6-2003 was valid and binding upon the Airpark and to its fill activities.

In November 2013, the court dismissed Airpark’s application against the City and declared that the City’s Topsoil and Site Alteration By-law was valid and binding upon it. The Airpark subsequently appealed the decision to the Ontario Court of Appeal. The Court of Appeal dismissed the appeal on June 13, 2014.

Following the decision of the Court of Appeal, the City continued to press the Airpark to comply with the Order to Comply under the City’s Site Alteration By-law. The City adopted a new Site Alteration By-law #64-2014 which contained materially the same provisions found in the previous by-law. The City maintained that the Order remained outstanding and it continued to be entitled to enforce it. The Airpark subsequently did file an application, however maintained that it was in relation only to a small area at the north-west corner of the Airport. This position

ignores all of the fill unlawfully deposited at the Airpark between January 1, 2008 and August 2, 2013.

litigation Round 2

The City commenced an application to the court in April, 2015 seeking an order to remove all fill deposited on site between 2008 and 2013. In the alternative, the City seeks to have the court order the Airpark to submit a complete application for a site alteration permit pursuant to the new City’s site alteration by-law. The application was heard by the court on November 10, 2015 and at the time of preparing this letter, the court has not released its decision.

Nature of Burlington’s Interest

The City of Burlington has a clear and compelling interest in the application for Environmental Compliance Approval that has been submitted to the Ministry of the Environment and Climate Change and posted on the EBR. As demonstrated above, the City has been engaged in a protracted dispute with the Airpark to regulate the fill that was brought onto the site illegally in order to address the environmental impacts resulting from those actions. In particular, the City is concerned with the grading of the property, and the impacts on the drainage of the lands, all of which are related to the proposed sewage works identified in the current application for compliance.

Councillor Blair Lancaster walking through the property of a farm adjacent to the air port found the land spongy and soaked with water – now we know where that water is coming from.

Prior to 2008, which was the start of the fill operations, the Airpark had a storm sewer drainage system that was located generally in the vicinity of the North­ South runway and the airpark buildings. These storm sewers discharged into the existing pond at the SE corner of the property and into the adjacent farm fields.

With the start of the fill operations, additional storm sewers were installed in the areas of fill. These storm sewers discharge into a regulated watercourse and also at several locations along the west property line. This has resulted in changes to the stormwater discharge regime onto adjacent properties. The change has been from the previous “sheet flow discharge” to “concentrated flow discharge”. As a result, adjacent properties have been adversely impacted, as identified above in the form of complaints received by the City.

The City agrees that the MOECC Environmental Compliance Approvals were required for these storm sewer systems. In addition, Conservation Authority permits should have been applied for. It is the City’s position that detailed storm sewer and stormwater design calculations should be provided for these systems. The application does not include adequate information in this regard.

Irregularities with the Present Application

City staff has had the opportunity to attend at the Halton-Peel District Office to view the materials filed by the proponent. The City submits that the application as filed contains a number of irregularities that merit the rejection of the present application on the basis of incompleteness.

Name of Proponent

Air Park entrance uly 2013

The ownership of the Air Park and the taxes they actually pay are now being questioned.

The name of the proponent making application for environmental compliance approval is 212091 Ontario Limited. The Certificate of Incorporation and the Articles of Incorporation attached to the application for that numbered company date back to 2006. Our recent corporate search of this company discloses that the numbered company was in fact amalgamated with the Burlington Airpark Inc. on January 1, 2007, forming a new company, Burlington Airpark Inc. being Ontario Corp. Number 1721779. Burlington takes the position that the application has been made by a defunct corporation which cannot have legal responsibility for the proposed works to which the application relates. The documents submitted in support of the applicant’s name are neither current, nor do they provide proof of the name of a genuine applicant. Furthermore, the documents submitted do not include copies of the subsequent articles of amalgamation.

Burlington submits that the proponent’s name as posted on the EBR is misleading, and a reasonable person having an interest in postings on the EBR respecting the Burlington Airpark Inc. would not have adequate notice of the application as posted in its current form.

Location(s) Related to this Instrument

The posting to the Environmental Registry identify the relevant address as 5432 Bell School Line, Burlington. Our information is that the actual address for the site is 5342 Bell School Line, in the City of Burlington. Again, any reasonable person having an interest in activities related to the Airpark would not have adequate notice that an application had been made for those lands. Also, 5342 Bell School Line is only one of three land parcels forming the Airpark lands.

Statement of the Municipality (s. 5.1)

The City notes that section 1.5 of the Application – Statement of the Municipality has been left blank. The Municipality has to indicate that it has no objection to the construction of the works in the municipality. I can assure you, that the City of Burlington, where the works are located has not been contacted and has not been consulted. Furthermore, the box has not been checked as “NA”.

Our understanding is that a municipal declaration is required from the municipality in which the sewage works are or will be located. The Ministry’s own “Guide to Applying for an Environmental Compliance Approval”, identifies that this declaration, “is required to establish the municipality’s general concurrence with the proposal, to ensure that the proposed works would not contravene any municipal by-laws or other requirements.” Also, the common law requires that the City be consulted in these circumstances.

Based on the background provided in this correspondence, the City of Burlington has very serious concerns about the sewage works identified in the application, and the municipality ought to have been consulted prior to the application having been made. The City takes the position that the installation of sewage works was done concurrent with the illegal infill operation that was occurring at the site, in contravention of the City’s site alteration by-laws.

Burlington’s Request

Barbara Sheldon look at 32 feet of landfill less than 50 feet from her kitchen window. All dumped without any permits because an airport is federally regulated. The city is not done with this issue.

Barbara Sheldon look at 32 feet of landfill less than 50 feet from her kitchen window. All dumped without any permits because an airport maintained they were federally regulated and did not have to comply with city bylaws.

The City of Burlington is requesting that the application be returned to the proponent as incomplete for the reasons as presented. The application contains incomplete and inaccurate information, and has the effect of misleading any person with an interest in tracking environmental activity on the EBR. The proponent ought to correct the application, and ensure that discussions are held with the relevant municipal authorities, including the City of Burlington and Conservation Halton before an application for environmental compliance is re­ submitted.

In the alternative, the City is requesting that the time for the submission of comments be extended for an additional 60 days beyond the current deadline of March 20, 2016 to permit adequate time for consideration of the issues by Burlington City Council, and affected residents.

Please note that these submissions are preliminary and deal only with the adequacy of the application and process followed to date. Should the application continue to be processed for approval, the City will submit its technical comments on the application for environmental approval.

If you require any further information, please do not hesitate to contact me.

Yours truly,

Nancy L. Shea Nicol
City Solicitor & Director of Legal Services cc. Mr. Ian Blue, Gardiner

This is the kind of document that would get circulated to council members and discussed in a closed session of council.  Our thanks to the citizen who had the courage to pass it along to the Gazette.

Return to the Front page

Meed Ward will issue a statement on the Council decision not to oppose the ADI request for an adjournment of the Nautique development.

News 100 blueBy Pepper Parr

March 15th, 2016

BURLINGTON, ON

Often, whenever ward 1 Councillor Marianne Meed Ward appears at events with the Mayor she sounds more "mayoral" than the man who wears the chain of office.

Mayor Goldring and Ward 2 Councillor Marianne Meed Ward.

The statement released by the city on the decision they made not to oppose the request ADI Development Group made to the Chair of the Ontario Municipal Board hearing for an adjournment that will push any decision forward to 2017 was so typical of this council. Every member of Council is on record as being opposed to the project.

What their thinking was during a two hour plus session of council is secret – but one would like to think that these high school graduates could say something.
Councillor Marianne Meed Ward did say : “This is the right decision and if no more comes from the city I will work with legal to draft a statement that can be shared, probably after the hearing tomorrow.”

Now you know why she is the odds on favourite to become the next Mayor of Burlington.

Return to the Front page

City council votes not to oppose the ADI request for an adjournment to the appeal they took to the OMB.

News 100 redBy Pepper Parr

March 15, 2016

BURLINGTON, ON

In an earlier version of this story we said Councillor Craven did not attend the Special Council meeting: we erred.  Council Craven was in attendance, Council Sharman was absent.

Burlington City Council voted to not oppose a request from Adi Developments to adjourn the Ontario Municipal Board hearing regarding the application for a 26-storey condominium proposed to be developed at 374 Martha St.

Recorded vote

Council members standing for a recorded vote not to oppose the ADI Development group’s request for an adjournment of the OMB hearing they sought. Councillor Sharman was absent.

In 2014, Adi Developments submitted an application to the City of Burlington for a 28-storey condominium to be developed on a .136 hectare parcel of land at 374 Martha St. Adi Developments launched the OMB appeal in March 2015. In February 2016, the developer amended its application to 26 storeys.

Martha Street bungalow

The bungalow on the right was recently purchased by the ADI development group and added to their land assembly on which they propose to erect a 26 storey condominium.

At the OMB hearing on March 14, the developer told the OMB it has bought the property at 380 Martha Street, and will include that property in its condominium development application. The city’s legal team asked for an opportunity to receive instruction from Burlington City Council.

The Chair of the OMB hearing asked the City of Burlington to have a response to Adi Developments’ request for adjournment by 3:30 p.m. today. The public was informed after 4 p.m. of City Council’s decision.

ADI Nautique detailed sketch

The property marked 380 was purchased by ADI and added to the original land assembly.

The OMB hearing will resume on Wednesday, March 16 at 10 a.m. in City Hall, Room 247, to deal with the developer’s request for adjournment and to establish a future process for dealing with the appeals that are currently before the board. The meeting is open to the public.

That was what the city had to say: What they didn’t comment on was that the adjournment will push the hearing back to sometime in 1Q of 2017 – that’s the earliest date the OMB can hear this case.
In their comments made while asking for the adjournment legal counsel for Adi said they believed many if not most of the concerns the city had expressed over the original development application could be resolved through discussion about the impact the additional property would have on the scale and scope of the project.

Nautique ADI rendering - sparse

The most recent rendering of the Nautique

Patrick Devine, legal counsel for the condo/apartment building directly across the street from the small piece of property that has been added to the land assembly amount to much more than a small change and should be seen as a new application and treated as such.

Unless someone objects to the adjournment, which could be as long as a year, things at the corner of Martha and Lakeshore Road are going to be quiet for some time.

Background links:

Original story on the ADI request for an adjournment of the OMB hearing they demanded when the city failed to act within the required 180 day timeline



Return to the Front page

Will city council get it right this time? An opportunity to revover from the first round handling of the ADI development on Martha Street.

SwP thumbnail graphicBy Pepper Parr

March 14, 2016

BURLINGTON, ON

Mayor and chair

Can Mayor Goldring keep his council focused and on topic in order to meet the two hour limitation he was given by the Chair of the ADI development appeal now before the OMB.

The Mayor is going to have to be brisk and focused when he chairs the Special meeting of Council Wednesday afternoon as they work through what they want to give their legal counsel in the way of instructions on the latest twist in the Nautique development that ADI took to the Ontario Municipal Board.

Nautique ADI rendering - sparse

Can a substantially revised development still be appealed on its original grounds? ADI purchases property to the north of their Nautique development site.

The ADI Development Group appealed their application to build a 28 storey structure to the OMB because they didn’t like the fact that the city did not give them a decision on their project within the required 180 day timeline.

Now they have the temerity to ask the city to go along with an adjournment for six months or more – and it will be more because there is no room on the OMB calendar until the 1Q of 2017.

There is also a bigger issue – the addition of a significant chunk of property to the development proposal would suggest that the OMB can (some say should) throw the appeal out and let ADI make a new application to the city.

The Mayor might have been better advised to call the meeting for 9:30 am – there is going to be a lot to talk about and there is significant doubt that this council can get through the jibber jabber they do when they debate in time to meet that 3:30 deadline put in place by the Chair of the OMB hearing.

City council recently approved the salaries for city council and reported on what council members were given in the way of expense and benefits money. On has to add about $60,000 to the number shown – this is what the council members get paid for their work as members of the Regional council.

Council vote Dec 18-14 Water Street

Recorded votes are not the norm for Burlington’s city council. In this instance Ward 2 Councillor Meed Ward votes against – it will be interesting to see if she demands a recorded vote for whatever comes out of the closed council meeting on Tuesday.

The debate that takes place, in a closed session of city council, which the Gazette believes is one of those occasions when the discussion should take place in camera; however the vote on what the city decides to do should take place in a public session where the public gets to learn what the question was and how individual members actually voted.

This is an important decision that gives the city an opportunity to bring a developer to heal.

One can hope that Ward 2 Councillor Marianne Meed Ward will do her duty and once again ask for a recorded vote – don’t let your constituents down Councillor.

Return to the Front page

ADI Municipal Board appeal gets adjourned until Wednesday so the city can instruct its lawyers on what they want to see done.

News 100 redBy Pepper Parr

March 14, 2016

BURLINGTON, ON

The fat is in the fire and there are deadlines out there that will be hard for some of the parties to the ADI Development Group Ontario Municipal Board appeal hearing to meet.

The Chair of the appeal to the OMB that ADI made is one Susan Schiller. Ms Schiller was one of the Commissioners who heard the Nelson Quarry appeal for an expansion to their quarry in North Burlington a few years ago. That Joint Tribunal found in the city’s favour. That decision was based on the habitat of the Jefferson Salamander – see the link to that story below. Ms Schiller is a no-nonsense chair – expect her to keep counsel on their toes.

The opening of the OMB hearing was in some doubt when Burlington city council announced on Thursday their would be a special council meeting on Tuesday at 1:30 pm to hear a legal update on the ADI appeal. The city said nothing other than it was related to a property at 374 Martha Street – which is the address of ADI’s 26 story Nautique development.

Martha Street bungalow

The eastern end of the site ADI wants to put a 26 storey condominium on and the bungalow to the north of the property at the Martha Street and Lakeshore Road intersection.

That was all we knew on Friday. At the hearing this morning we learned that ADI had purchased the small bungalow tucked in behind the property ADI had assembled for the Nautique project.

And here is where the differing interests come into play.

ADI Nautique detailed sketch

The ADI development group purchased the property at 380 Martha Street and has asked for a delay of their OMB appeal while they work with the city to figure out how to integrate the property into the original development. Some argue that the purchase of the property makes the development a whole new ball game.

ADI wanted the hearing delayed until the fall while they worked out how they would fit the newly acquired piece of property into the larger development. The lawyer for the city said he couldn’t agree or disagree with the ADI request until he had directions from his client – the city of Burlington. The meeting at which the city will work out its position is to take place on Tuesday at 1:30 pm

Burlington City Council Group

Can this council make a critical decision in the 120 minutes they were given by an OMB commissioner? Don’t bet the mortgage on it.

Chair Schiller said she was fine with adjourning the Monday meeting until Wednesday morning but she needed a decision no later than 3:30 pm on Tuesday.

It will take someone with a big magic wand for that to happen. The city has 120 minutes to arrive at a decision – with seven council members they each get 17 minutes – that won’t happen. Add in the staff comments; the comments from the lawyers and there goes that deadline.

The decision the city has to make is – are they willing to go along with the ADI request for an adjournment until the fall?

The complications get thicker.

There are those who want to argue that the Chair of the OMB hearing should throw the appeal out right now because the addition of a piece of property to what is an appeal means that this is in reality a whole new development.

ADI appealed because they weren’t happy with the city’s inability to approve or disapprove of the application within the 180 days required under the planning act and wanted to the OMB to make the decision.

The addition of that piece of small bungalow at the north end of the property means this is really a new development.

Nautique ADI rendering - sparse

Has the ADI Nautique development reached the point where it has entered that “will never see the light of day” zone?

What ADI will argue is that the chair does not have the jurisdiction to refuse to go forward with the appeal application. The city and the owners of a condominium across the street from the bungalow (Sun Life Insurance) will argue that the Chair cannot hear the ADI appeal because the project has had a substantial change made to it.

Patrick Devine, the lawyer representing the Sun Life interests argued that a new project proposal should be submitted by ADI to be followed by the requisite public meetings and a review by the planning department.

He also complained about the short notice he was given by the ADI lawyers on their decision to buy the bungalow – which is reported to have been owned by Nick Carnicelli, the developer behind the Berkeley project on Caroline and John Street that is getting closer to putting a shovel in the ground. Carnicelli also has other property holdings in the block bounded by Martha, Pearl and Lakeshore. A number of years ago Carnicelli bought the Pearl Street Café and a critical strip of property in behind those two buildings.

It is all a bit of a mess – there are pretty good grounds for throwing the ADI appeal application out; that argument will be something to watch.

ADI seemed to be suggesting that with the acquisition of the really small bungalow many of the objections the city had to the development could be worked out. The current zoning for the property ADI wants to build on is for 8 storeys – how a small bungalow is going to impact the 26 storeys ADI wants to put up is going to be an interesting legal argument.

Would it be reasonable to come to the conclusion that the ADI decision to purchase the bungalow at this late date is pretty close to “flying by the seat of your pants” decision making.

For those who have made deposits on units in the proposed development – it’s going to be a while before you can move in.

Chair Schiller advised the meeting this morning that if the hearing is adjourned – there is no room on the calendar for a resumed hearing until sometime in the 1Q of 2017.

Return to the Front page

Burlington and two of its OMB hearings; one is taking forever - the other begins next week.

News 100 blackBy Pepper Parr

March 10, 2016

BURLINGTON, ON

Ontario Municipal Board (OMB) hearings are relevant and for the most part – as dry as unbuttered toast – they are also where some big money gambles get resolved.
Burlington has two hearings on the docket – Ward 4 Council member Jack Dennison’s appeal of a Committee of Adjustment decision that did not permit his request for a severance of his 308 Lakeshore Road property.

A designated home, bought under a power of sale on a HOW WIDE LOT which the owner. Councillor Jack Dennison wants to have severed into two lots.

A designated home, bought under a power of sale  which current owner Councillor Jack Dennison wants to have severed into two lots.

His OMB appeal was first heard on April 29, 2013 – yes three years ago. That hearing was adjourned as was the May 29th, 2014 and the September 23, 2014 hearing.

The appeal was heard on April 21st, 2015 and continued on June 22nd 2015.

Nine months later – and still no decision. This was thought to be a pretty simple severance request; something isn’t right here. But don’t expect an explanation from the OMB – one day the decision will be posted on the OMB web site. The lawyers involved will be notified that a decision has been made and they will get a copy. OMD decisions cannot be appealed – so in the fullness of time Jack Dennison will know if he can sever a portion of his property.

City council knows what this appeal has cost – will they make the amount spent public?

Will Dennison run for his council seat in 2018? If the public gets wind of what it has spent on this case and if there is a credible candidate – he could be in trouble.

Dennison announcing

Jack Dennison announcing the sale of his Cedar Springs health club.

Retirement might be in the works for Dennison – he recently announced the sale of his Cedar Springs sports club.

ADI project - rendering from LAkeshore

Early rendering of a proposed 28 storey structure that cantilevered over the street at the upper level. Tarif Adi explained at the launch of the development that the idea was to have the building look like a “billowing sail” that would be seen as a statement for people entering the city from the east on Lakeshore Road.

The second significant matter on the OMB docket is the appeal the Adi Development Group has made to the OMB claiming that the city “refused or neglected to make a decision on the Official Plan change and zoning application” made by Adi for the development of a 28 storey structure on an .070 piece of land at the intersection of Martha and Lakeshore Road.

The public got its first look at the proposed development on Oct. 9, 2014, Burlington Art Gallery at 7 p.m. It was not a happy meeting. Many of the people in the room realized then that this project was headed or the OMB.

While Council didn’t hold a vote on the application until very recently – the development was contentious from the day it was first shown at a public meeting.

The Gazette has written extensively on this development and was the recipient of a libel claim by the Adi Development group. The Gazette was asked to apologize for three articles it published and to take them off their web site.

An apology was published and the three articles are no longer no longer available to the public on the Gazette web site.

The proposal is complex. No one on council liked the project – or at least that was what they said publicly – Ward 1 Craven retweetCouncillor Rick Craven re-tweetd a notice of the public event.  For a council member on record as being opposed to the development – the re-tweet seemed inappropriate – bu then Adi has a massive development planned for Aldershot – maybe that explains his enthusiasm.

In a staff report on the proposed development the planners said:

Refuse the applications for Official Plan and Zoning By-law amendments, submitted by Andrew Ferancik, Walker Nott Dragicevic Ltd., 90 Eglinton Avenue East, Toronto, ON, on behalf of ADI Development Group Inc., to permit a mixed use development consisting of 226 residential apartment units and 348 m2 of ground floor commercial development, on the property located at 374 Martha Street.

Unfortunately, this recommendation didn’t get to a city council meeting for a vote. By the time the city council meeting took place Adi had filed their appeal to the OMB.

Council did hold a vote a number of weeks ago.

It is a complex situation and the city didn’t exactly wrap itself in the corporate flag – they looked like the Keystone cops for a short period of time – but sloppy administration isn’t reason to approve a proposal that doesn’t meet most of the public policies the planners think they should meet.

Adi submitted the following reports to support their application:

1. Planning Justification Report (prepared by WND Associates, September 2014)
2. Functional Servicing Report (prepared by Urbantech West, August 2014)
3. Geotechnical Investigation (prepared by Landtek Limited, February 2014)
4. Phase One Environmental Site Assessment (prepared by Landtek Limited, February 2014)
5. Traffic Impact Study (prepared by Paradigm Transportation Solutions Ltd., August 2014)
6. Noise Feasibility Study (prepared by Howe Gastmeier Chapnik Ltd., September 2014)
7. Pedestrian Wind Study (prepared by Novus Environmental, August 2014)
8. Shadow Studies (prepared by RAW Architects, August 2014)
9. Site Plan (prepared by RAW Architects, August 2014)
10. Tree Inventory & Preservation Study (prepared by Adesso Design Inc., June 2014)
11. Floor Plans (P1-P5, Levels 1-28, Rooftop Terrace Plan and Roof Plan)
12. Elevations (prepared by RAW Architects, August 2014)
13. Sections (prepared by RAW Architects, August 2014)

Planning staff explained that OPA and rezoning applications are subject to the following policy framework: Provincial Policy Statement, 2014; Places to Grow: Growth Plan for the Greater Golden Horseshoe; The Big Move; Halton Region Official Plan; Burlington Official Plan and Zoning By-law 2020.

Adi - Saud and Tarif

Saud and Tarif Adi

They provided summaries of their position on all of the policy statements.

Planning Opinion on the PPS:
While the proposed development is consistent with the PPS in principle, the proposal represents over-intensification on a site that is too small and does not provide adequate setbacks, buffering, amenity space or parking standards. The significant reduction of numerous development regulations that are required to facilitate this intensification proposal on the subject property and the failure to satisfy the City’s Official Plan policies described in Section 8 of this report results in an application that is not consistent with the PPS.

Planning Opinion on Places to Grow:
The subject applications generally conform to the principles of the Growth Plan by accommodating intensification in an area that is designated for intensification, and more specifically, within the Urban Growth Centre. However, the subject applications are not proposing an appropriate scale of development and the proposed development does not achieve an appropriate transition of built form to adjacent areas. The City’s existing intensification strategy is well positioned to meet the minimum density target established in the Growth Plan without significant changes to the existing Official Plan policies and permissions. The City does not require the overdevelopment of one small property in the Urban Growth Centre in order to achieve the minimum density target.

Big Move logoPlanning Opinion on the Big Move:
The proposed development generally conforms to the vision of the Big Move. However, the City can meet its targets without the proposed over-intensification of this site.

Planning Opinion on the Regional Official Plan:
While Region staff generally has no objection to the proposed development on the basis that it conforms to the Region’s growth policies, City staff is evaluating the applications on the basis of land use compatibility. The proposed development represents the over- intensification of a very small site, does not provide an urban form that is complementary to existing developed areas and does not achieve an appropriate transition of built form to adjacent areas.

Planning Opinion on the City of Burlington’s Intensification Strategy:
The City has conducted several conformity exercises and has developed a comprehensive approach that balances the protection of neighbourhoods and the accommodation of compatible intensification in appropriate locations. As outlined in Section 7 of this report, staff is confident that the density targets established in the Growth Plan, Regional Official Plan and City Official Plan will be achieved by 2031 without amendments that significantly depart from the City’s Official Plan.

Mobility hubs at the GO stations is close to a no brainer - it is the possible hub in the downtown core that has yet to be thoroughly thought through. Council decided that closing the terminal on John Street to save $8000 a year was not a bright idea.

Mobility hubs at the GO stations is close to a no brainer – it is the possible hub in the downtown core that has yet to be thoroughly thought through. Council decided that closing the terminal on John Street to save $8000 a year was not a bright idea.

Planning Opinion on the Mobility Hub Opportunities and Constraints Study:
The MHOC Study has no policy implications at this time, but staff is of the opinion that the proposed development would not be in keeping with the principles and preliminary directions stemming from the MHOC Study. Staff also notes that future master planning exercises for Mobility Hubs will determine detailed site-specific requirements should changes to the Official Plan be deemed appropriate. In the interim, prior to the completion of a Downtown Burlington Mobility Hub master plan, development proposals will be required to meet the Official Plan policies that are in effect. If Council approves Mobility Hub objectives that are incorporated into the Official Plan as a result of this Official Plan Review, then de elopment proposals will be required to me t those objectives until such time as the master planning exercise is completed.

Planning Opinion on the Urban Growth Centre Targets:
Adi - Urban growth centre boundaryBased on the development patterns that have taken place in the Urban Growth Centre in the past ten years, staff is of the opinion that the City of Burlington is well positioned to achieve a total of 200 residents and jobs per hectare by 2031 taking into consideration the existing Official Plan permissions and zoning regulations within the Downtown.

Planning Opinion on the City of Burlington’s Official Plan:
The proposed development represents residential intensification and is therefore subject to the housing intensification objectives and policies in the Official Plan. The proposed development provides additional housing in the form of residential intensification, but the proposed development is not compatible with the scale, urban design and community features of the neighbourhood and does not meet the objective of the housing intensification policies.

The nearest residential buildings are the one storey detached residential dwelling to the north and the three storey townhouses to the northwest of the subject property. A five storey retirement residence is located on the east side of Martha Street and a 12 storey apartment building is located further northeast from the subject property. The proposed four storey podium which contains a three level parking garage with a 24 storey tower above at this location does not integrate well with the existing neighbourhood and does not provide an appropriate or a compatible transition between the existing and proposed residential buildings.

In fact, many of the taller residential buildings in the area are located northeast and southeast of the subject property and the existing buildings have greater setbacks from the street and from adjacent properties. The block containing the subject property generally has a lower density built form with building heights ranging from 1-3 storeys and the proposed development does not provide setbacks from the street nor from adjacent properties.

Nautique ADI rendering - sparse

A more recent rendering of what has been named the Nautique

The proposed development fails to satisfy a number of intensification criterion including

• the provision of off-street parking;
• the achievement of compatibility with the existing neighbourhood character in terms of scale, massing, height, siting, setbacks, coverage, parking and amenity areas to provide a transition between existing and proposed buildings;
• the provision of adequate buffering; the compromised redevelopment potential for the abutting property located at 380 Martha Street;
• the requirement for intensification proposals to be well integrated with the existing neighbourhood in terms of built form, scale and development profile in order to provide a transition between existing and proposed residential buildings;
• the building height, massing and density lead to the overdevelopment of a very small lot; and
• the proposal represents overintensification.

The proposed development fails to satisfy the residential intensification policies of the Official Plan and does not represent good planning.

Planning Opinion on the Downtown Urban Design Guidelines:
The proposed development is not in keeping with the City’s Downtown Urban Design Guidelines for high rise development for the following reasons:

• the building setbacks are not sensitive to the existing built form;
• the building does not propose stepbacks to reduce the perception of building bulk from the street;
• the building does not utilize the results of the visual angular plane study to determine the appropriate building height and/or massing;
• the tower is not located away from the corner of the two intersecting streets;
• the building height, mass and architectural design present a tall, boxy structure that does not reinforce human scale;
• the impact of the high rise development on adjacent properties has not been appropriately minimized through a transition of height, mass, separation and landscaping;
• three levels of above-grade parking that address the street are proposed;
• the proposed development does not clearly express a podium at the street level with a proportion and massing that is consistent with the surrounding built form;
• the proposed development has not been designed to provide a height transition to the surrounding lower scale developments to minimize the shadowing and wind impacts; and
• the negative impacts on adjacent properties related to overshadowing and overlooking have not been addressed through building setbacks, stepbacks, height and massing.

ADI storefront

The Nautique sales office on Brant street in a building owned by the Region

Planning Opinion on Zoning By-law 2020:
The zoning changes requested are excessive. The site as proposed would be overbuilt and should not be approved.
The siting of the proposed development is partially responsible for the perceived scale and massing of the building. The building will address the corner of Lakeshore Road and Martha Street and proposes no setbacks along the adjacent property lines to the west and to the north. The building footprint will cover almost all of the lot and leaves no room for vegetation or separation distance from adjacent buildings.

ADI Nautique detailed sketchThe siting does not provide any “breathing room” between the proposed building on the corner property and the adjacent buildings to the north and west; the proposed building will appear “crammed” into the block. The siting of the proposed development is not compatible with the existing neighbourhood character.

Is the development selling? Do people want to buy units in the proposed 26 storey structure? Adi has not released any sales figures. In a news report they said they have received more than 3000 expressions of interest – those are not sales; just people kicking tires.

Adi has promoted the project heavily within the real estate community and are offering generous commissions. They held an event at their sales office on Brant Street for the real estate agents offering Valet parking.

Return to the Front page

The evolution of a piece of land on the south side of Lakeshore Road.

News 100 redMarch 8, 2016

By Pepper Parr

BURLINGTON, ON

We knew it as the location of the Riviera.

The Riviera Motor Court began operations in 1963. The two level, 32-room motel offered guests a beautiful view of Lake Ontario along the back portion of the motel.

The earliest information for a manager was a Mr. William Dikeman. In 1984 the motel was bought by Mr. John Lee who incorporated it as 558644 Ontario Limited.

Riviera from front

The Riviera on the Lake – lots of stories.

The last managers to operate the business were Peter and Yolanda Piekarski. Annual profits were in the area of $242,000.

Riviera balcony west side

The balconies at the rear of the motel made the room rate worth every dime.

There was nothing exceptional about the motel – it was the view of the lake from the units at the back of the building.

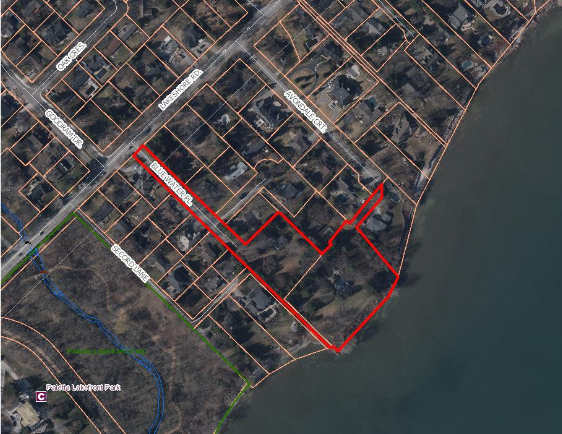

The 0.7-hectare, block-long property between Elizabeth and Pearl streets just east of Brant was assembled over time. The Lakeshore Road portion was part of a land swap that had the city giving some land in exchange for a shoreline walkway at the edge of the lake which has been in place for a number of years.

Sales office Bridgewater

When you reach the 70% plus level in sales you don’t need a fancy demonstration site – it had to make room for the construction equipment.

In 2006, Burlington city council approved plans for a new construction project on the property. The project, now known as Bridgewater, has been delayed over the years due to economic factors as well as difficulty in obtaining a developer and hotel partner.

Bridgewater - sales office gone BEST

Construction workers stripping away what is left of the sales office for the Btidgewater project on Lakeshore Road.

Bridgewater was to have a 7-storey hotel at street level, that got increased to eight storeys; a 7-storey condo behind the hotel and to the west of both buildings, a 22-storey condo. The condo would obscure the view of Lake Ontario for those living in the condos on the opposite side of Lakeshore. The new buildings would feature a central courtyard open to the public that would lead to the walkway along the water.

The property is owned by Mayrose Tycon who, since 1994, were focused on finding a developer to undertake the construction and to take over the property.
Mady Development Corporation was named but they were taken off the site due to a tricky clause in their agreement with Mayrose Tycon.

ccvbggh

The motel is long gone but the walkway that will eventually run from this point all the way to the canal was built a number of years ago as part of a land swap with the city.

The project was “in the works” for the longest time; Conservation Halton had informed Mayrose that if development did not occur on the property by the end of 2012 they would lose between 15 to 20 feet of shoreline property under a new Ontario Regulation.

That got things moving – Mayrose had to get an extension from the Conservation people but that didn’t immediately result in shovels in the ground. It wasn’t until New Horizons was invited to develop the site that one got the sense that this was really going to happen.

Jeff Paikin, known for quality work with a number of solid projects under his belt.

Paikin had bought a unit in the project and was later invited to do the development.

It has been nothing but solid progress since then. Sales of the project are reported to have passed the 70% point. There will a planned 150 units in the two condominium towers.

Bridgewater - consruction equipment - 12 pieces

A collection of 12 pieces of heavy duty construction equipment are on the site – they give a whole new meaning to “shovels in the ground”

Paikin’s partner Joe Giacomodonato handles the actual construction work.

At one point the hotel was going to be open for the Pan Am Games in 2015.

As for the Riviera the writing was on the wall in 2010. They began offering rooms on a monthly basis only. The Region of Burlington paid Riviera to house the city’s homeless people and immigrants.

In April of 2012 the municipal building code department and fire department served a notice on the owners that they needed to bring the building up to code or close it down.

The owners decided to close the building which was boarded up.

On August 18, 2012, the building came one step closer to demolition when a fire broke out in the hotel, caused by arson.

The 2015 Pan Am date came and went; the designated developer of the site changed but the project had just too much value built into it to not go forward.

Three structure project has been the "in the works" since 1985 when developers were given the right to build a 22 storey plus building on the property where the Riviera Waterfront Motel used to exist.

Three structure project has been the “in the works” since the early 1990’s when developers were given the right to build a 22 storey plus building on the property where the Riviera Waterfront Motel used to exist.

Last week the sleek sales office met its turn with the wrecking ball. The south side of Lakeshore Road lost its parking meters and traffic is being restricted for a couple of weeks while large concrete pipes get buried. What was the Riviera is now the construction site for an upscale condominium that will consist of a seven story and a twenty two story structure attached to each other by a four level underground garage.

The site will include a four star Mariott hotel – the opening date is still pencilled in as 2018 – those things tend to be pretty loose until construction is well under way.

The four floors down garage work will get started soon; the grade of Elizabeth will change and slowly but surely the Bridgewater will rise out of the ground and reach 22 storeys into the sky.

The 22 storey structire that is due to be built on the waters edge will forever change the look of the city. For the better?

An architectural rendering of an aerial view of the Bridgewater project from the lake side.

The view from the top floor be something to experience.

Paikin, who is a marketer at heart will tell anyone who is within earshot that : “The design is so fantastic and the location is probably the No. 1 location in all of Ontario, if not Canada, as a place to live.”

He might be right.

Return to the Front page

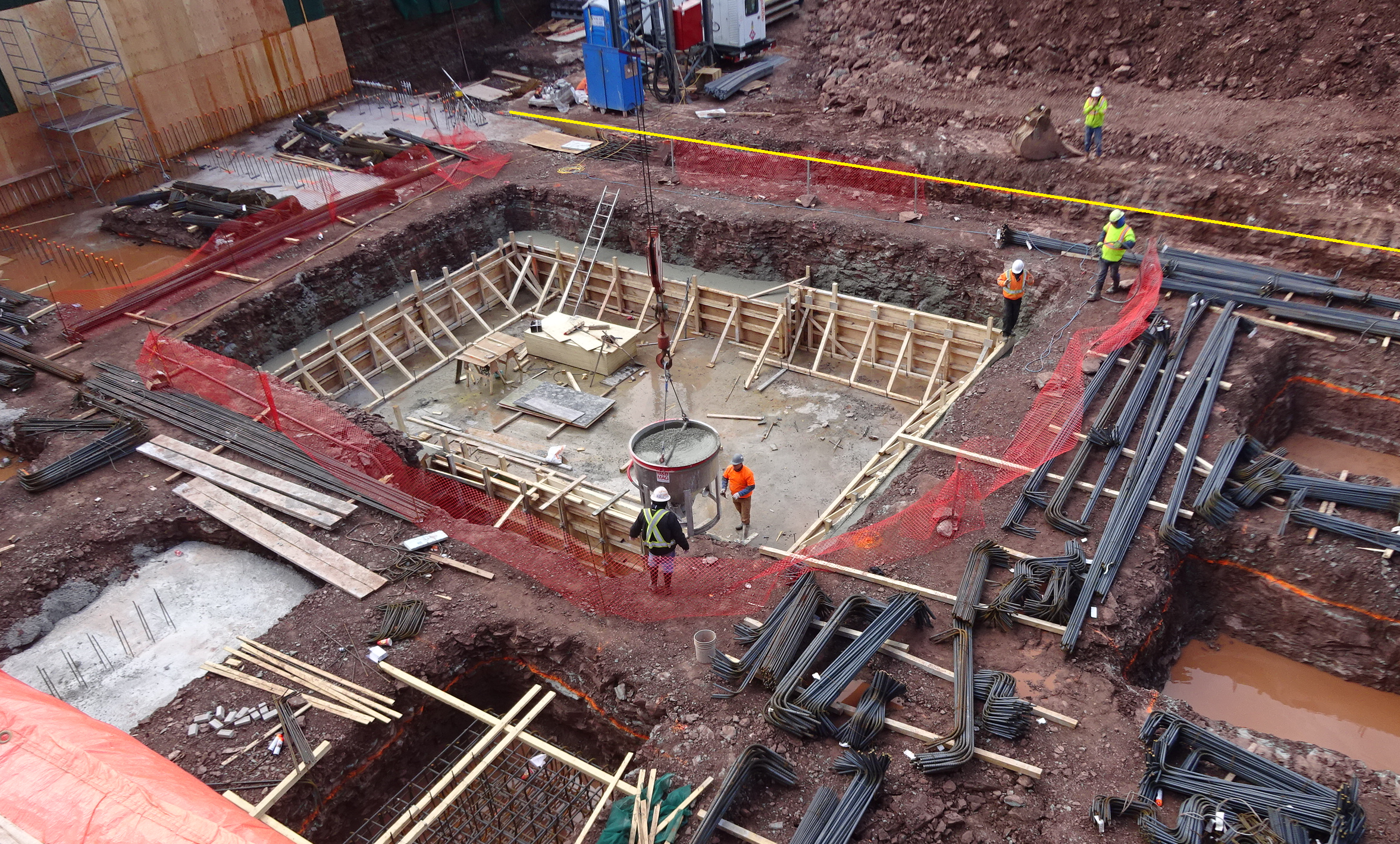

Developer constructing three towers at the same time on Fairview for a community of 2000

News 100 redBy Pepper Parr

February 6th, 2016

BURLINGTON, ON

The weather is working for them, the construction time line is a little ahead of schedule and Rodger Park is a happy man.

Trucks are rolling in with concrete and flatbeds haul rebar onto the site of the five tower Paradigm on Fairview right beside the Burlington GO station.

A full crew of workers is distributed amongst three of the towers at the back of the property where they are either digging into the shale, laying out rebar, doing concrete pours or stripping away the forms on concrete that has been poured.

Ryan with a conccrete bucket

Rigger Ryan Vandermeer maneuvers a cement bucket for loading.

Two cranes swing through their arc lifting a load of rebar rods or hoisting a big bucket of concrete. John Caronello is handling the big crane on tower A on the west side of the construction site while his rigger Ryan Vandermeer keeps in constant communication.

Some of the concrete mixing trucks carry 9 metres of concrete while others are limited to 8 metres – it is all subject to quality control testing. They don’t leave much to chance.

Wael Deiab scoots around the site with pails of concrete that he is testing for consistency, air content and compression. Nothing fancy about the lab he works in – outdoors where he pushes concrete into a cylinder where it will stay for testing – which gets done at the three day, seven day and 28 day time frames.

Landtek - concrete testing

Wael Deiab pours concrete samples into canniters and tests it for consistency.

Deiab, who works LandTek, the company that does the concrete quality testing, drops in on a site and randomly chooses concrete that is being poured – fills his bucket and takes it away to a place out of the wind and starts his testing. Temperature of the concrete is included in the testing.

Concrete pour tower c

Concrete being loaded for a pour on tower B at the Paradigm site on Fairview

Tower A, on the west side of the site, reported to be sold out, has its two parking levels completed – they are now working on the ground floor.

Jason Park, who backs up his Dad, Rodger Park quietly checks on what is being done – he tends not to look you in the eye – he is constantly watching to be sure that things are going the way they are supposed to go.

How much concrete will be used in this five tower project – Jason doesn’t have a clue – he doesn’t care where it comes from either – just as long as it arrives on time.

Concrete trucks

Concrete can come from any one of four locations in the Burlington area – 8 to 9 square metres at a time

The concrete can come from any number of locations – the driver of the truck is the guy who cares about where he is going to be driving to next.

It’s a Friday, the site will shut down for the weekend – on balance it has been a good week.

The schedule is being met – three buildings all going up at the same time – each in various stages of completion.

It gets a little boring after a while said Jason – we put up forms, pour concrete, strip away the forms and move on to the next level he explains.

The elevator shaft for building A is coming together – one can get a sense as to where the front entrance to the building is going to be.

The three towers at the back of the property are works in progress – the thinking for the smaller towers at the front closer to the street are part of the project – when construction on those towers actually begins is a market research exercise.

Sales of the units in towers A, and B are going very well. What the Molinaro’s are doing is creating a new community of 2000 people. There will be changes in the way that part of town works. Will the Paradigm pull the downtown core right up to Fairview – what impact will all those people have on the commercial sector.

One can expect a least a couple of restaurants for all those people. There will be some commercial space on the second floor of the two towers that will front on Fairview.

The Molinaro’s built the condominiums that line Lakeshore Road – and in the process defined the downtown core we have today.

Will the same thing happen to Fairview?

Return to the Front page

Putting the Mayor’s State of the City in context.

SwP thumbnail graphicBy Pepper Parr

January 29th, 2016

BURLINGTON, ON

He is getting better  as a speaker; one of his council colleagues suggested he was getting some training.

Another council colleague said “he went on to long”.

Ok – but what did he say?

There were no “announcements” – he just ran through the things that had been done, mentioned several of the senior staff additions and got one decent joke in.

There wasn’t a standing ovation.

Flood Fairview plaza

Business people know that problems like this need a resolution – all they heard on Thursday was that more money was going to be thrown at it.

The Mayor made very small mention of a possible storm water tax levy – his audience was a combination of senior city hall staff and business people.

Intensification got several paragraphs. If we understood the Mayor correctly, Burlington has already reached its 2031 target.

The Mayor made much better use of good visual aids – at one point he put up three pictures; one of Waterdown Road as it is today – with its widening and a nice new coat of asphalt; a second on what is possible in terms of height under existing zoning and told the audience that if the people of Aldershot wanted a supermarket all they had to do was go along with those higher buildings.

It is clear that the Mayor hasn’t taken in a planning meeting in Aldershot – those folks want to keep their bungalows and streets without sidewalks.

There was quite a bit of time spent on the strategic Plan – he did mention that it was late – made no mention of the cost and didn’t touch on the content – not even a couple of tease lines. The audience he was talking to Thursday morning is going to be very disappointed when they see the final document – unless there are massage changes from the draft versions.

It was a dull speech – the Mayor doesn’t do barn burners – but gosh, golly, gee could he not have said something that would have the business men and woman in the room sitting up in their chairs?

The city planning department has been working on the concept of mobility hubs and there are still those prosperity corridors being talked up.

Mobility hubs

While the city council has not actually said that the |Aldershot GO station is where the first mobility hub is going to be located – all the signs point to that location.

Those start ups the Mayor is so hungry for got another mention and the Advanced Manufacturing Hub that former Prime Minister promised us is still in the works. But he didn’t drill down into just what this would mean for the business community.

The Mayor did mention the newest speaker he has coming to town – this time it is going to be Brent  Toderian who has said  “good planning is not a popularity contest.”    Toderian will talk about the need for city’s to grow “up” and not out at the Royal Botanical Gardens February 12th.

Mayor Goldring seems to want to go back to the Burlington of the 1970’s when he knew everyone in Roseland where he lived at the time – he longs for that “small town fee”.

He touched on the Community Investment Plan that is going to put small amount of money into community groups and let them plan and run recreational event in their communities.

“We are an engaged city” said the Mayor – it would be really wonderful if the he expanded on what he means by “engaged” because Mayor Rick Goldring certainly didn’t engage his audience Thursday morning over breakfast at the Burlington Convention Centre

Return to the Front page

Mayor gives the business community his take on the State of the City - sunshine and roses.

News 100 blueBy Mayor Rick Goldring

January 29, 2016

BURLINGTON, ON

The Gazette has published the Mayor’s State of the City report for most of the last five years.  Links to previous addresses at at the bottom of the 2016 address.

Theologian Leonard Sweet said, “The future is not something we enter. The future is something we create.” Today, I would like to talk to you about Burlington’s future.

Mayor and chair

Mayor Rick Goldring.

I am pleased to share that after more than a year of cooperation and collaboration between the community, City Council and city staff, Burlington’s 2015 to 2040 Strategic Plan is almost finalized. Staff is currently making final revisions based on your feedback before sending the completed document to council for approval this spring.

The city is undergoing an important transition, one that some municipalities don’t step up to. In addition to our core mandate of providing a range of critical city services, council has decided to add a new mandate, to actively “city-build.”

City-building entails using all of the tools available to council and working with partners to actively shape the physical, social, economic and cultural fabric of the city.

The new Strategic Plan is fundamentally different than past plans. It is the twenty-five-year blueprint for city-building, and will be supported in more detail with the Official Plan, Transportation Master Plan, and the Corporate Work Plan. Collectively these plans will be setting ambitious, clear and measurable targets for physical growth, sustainability, carbon neutrality, economic growth, changing how people move around the city and how we engage with the public.

Burlington is one of the first Southern Ontario municipalities to stop sprawling and instead grow in place, something many other municipalities will be faced with in the next decade or two. We are leading the way, and are the ‘poster child’ for David Crombie’s recent report on how municipalities in Southern Ontario should be evolving.
As we stop sprawling, we are now going to focus more deliberately on our rural area through our Strategic Plan and Official Plan.

In preparation, we are actively changing our internal management structures, planning processes, and where necessary, skills and resources to support this new agenda.

There are four key directions outlined in our new Strategic Plan, including: A City that Grows, A City that Moves, A Healthy and Greener City and An Engaging City.
Today, I will talk about these directions, highlight the objectives in each section and discuss achievements of the past year related to the four strategic themes.

A City That Grows

A City That Grows is one where Burlington is a magnet for talent, good jobs and economic opportunity while having achieved intensification and balanced, targeted population growth for youth, families, newcomers and seniors.

Promoting Economic Growth
I believe that economic development is the key to a vibrant, prosperous Burlington – whether five or twenty-five years into the future.
Our results in 2015 were steady. Our key metrics are in line. However, vacant employment land supply is low and we are working to activate key employment lands to provide some much-needed inventory for business to locate.

We are also working through our Official Plan and recognizing that with over 88 per cent of employment land already in use, and a large portion of this development more than 50 years old, we need policies to support redevelopment of these employment areas.

Several expansions took place, most noticeably Cogent and Evertz with significant physical expansions. There are many others in our community with aggressive growth plans.

We are working on a number of office and industrial developments for 2016 and we expect to continue to meet out targets in the short term.

As the global economy becomes more and more connected, innovation and globalization are critical to our future. With global competition and the race to low labour costs, our businesses must innovate and utilize new and emerging technologies, supply chains and intellectual property to prosper.

Cities and governments around the world recognize this. Investments in innovation and industry coordination are increasing in certain jurisdictions. Germany and Austria, for example, have introduced Industry 4.0 and are investing more than 70 billion Euros to ensure that manufacturers are operating at the leading edge. The U.K., U.S. and many others are moving in this direction.

The province of Ontario is recognized as one of the best places to start a business. We are not, however, having the success we need growing these businesses. Data shows that 75 per cent of new jobs come from new businesses, primarily between year two and year seven of operations.

Recognizing these trends, our focus for economic development is shifting. Traditionally, we have focused on retaining the businesses we have. Going forward we will be:

Focusing on supporting start-up and growth businesses.
Developing a Regional Employment and Innovation District, which better reflects the work environment companies are looking for and is connected to our highway and public transit network.
Supporting population growth and initiatives to attract and retain the talent that we need to have. This includes youth, young families and professionals, and a more welcoming environment for newcomers.
Improving our transit connectivity to employment areas including looking beyond our borders is critical. After all, almost 35,000 people go back and forth for work between Burlington and Hamilton every day.
Working with our post-secondary education partners to ensure that employers have the talent that they need and that we as a community are taking advantage of the more than 10,000 annual graduates from our local institutions. We are currently working with Mohawk, Sheridan, Brock and McMaster to provide better access to research and development for local business.

McMAster Univesity is developing a three year program that will significantly improve the management skills of senior and middle management staff at city hall. As many as 150 staff members will be taking courses over a thtree year period.

McMaster Univesity De Groote School of Business is adding a fourth floor.



Within the coming months, DeGroote will be finishing the fourth floor of the Ron Joyce Centre. This will be the home of the new Michael G. DeGroote Health Leadership Academy, as well as a Centre for Evidence Based Management. McMaster’s DeGroote School of Business is also launching their new Executive MBA program in Digital Transformation this year.

In 2016, we will continue to work with industry, education and senior levels of government to support the development of an Advanced Manufacturing Hub in Burlington, which will assist manufacturers in Burlington, Halton and Southern Ontario in becoming more competitive globally.

Burlington has a strong, diversified local economy. We will continue to support this, and invest in the future to ensure prosperity in the long term.

Intensification

Intensification is another key aspect to the future of our city outlined in the proposed Strategic Plan.

Burlington intensification areaINSERT

To understand intensification – the greater concentration of people living and/or working in a defined area – we need to understand what factors are influencing the future of Burlington.

Burlington is built out. There is very little room left for traditional greenfield suburban-type development. Fifty per cent of Burlington is rural, agricultural, natural greenbelt and the vast majority of people I talk to want to keep it that way. North Aldershot, Mount Nemo, Lowville and Kilbride areas house the Bruce Trail, Lowville Park, the Cootes to Escarpment Eco Park System and many other natural features. As the Greater Golden Horseshoe Area becomes more urbanized, the importance of maintaining these assets will only magnify.

Primarily because of immigration, 150,000 people move to the Greater Golden Horseshoe area every year resulting in 3.7 million new residents and 1.8 million new jobs in the next twenty-five years.

The Ontario government released the Places to Grow Plan for the Greater Golden Horseshoe in 2006 defining how we should accommodate this growth.

Halton Region agreed to accept growth of 315,000 people and 175,000 jobs by 2031, with best planning estimates stating that Milton will grow to 228,000, Oakville 246,000 and Burlington 186,000 by 2031. Burlington is close to 186,000 people now.

In a city that is out of traditional greenfield land, where 50 per cent of our city is protected greenbelt land, the next question is: Where do we grow?

Downtown is an Urban Growth Centre in the Ontario Places to Grow Plan and is targeted to have approximately 200 jobs and people per hectare by 2031. It is two-thirds of the way there now.

Our Official Plan also identifies other sites suited for intensification, such as Uptown located at Appleby Line between Mainway and Upper Middle Road.

The Fairview/Plains Road corridor. When we talk about the transformation of Plains Road through intensification, it is important to recognize the leadership and vision of Councillor Rick Craven.

Site with GO in background before sunrise

Five tower Paradigm project on Fairview at the GO station is selling very well.

The areas around our three GO Stations – Aldershot, Burlington and Appleby.

Aging retail plazas like Roseland, Eastway and Lakeside.

We anticipate that 80 per cent of our urban area will not experience significant change.

If we take federal and provincial policies out of the picture, what makes sense when it comes to residential growth for Burlington? Would we intensify regardless of growth policies?

According to city planner and former Vancouver chief planner, Brent Toderian, the advantages of creating more density, if done well, are:

Facilitating more affordable housing choices
Curbing the negative impacts of sprawl
Mitigating climate change
Dramatically decreasing energy costs
Increasing energy independence
Making walking, biking and transit more inviting
Improving public health, diversity, creativity, safety and vibrancy

These advantages are possible if density is created in an appropriate manner.

I would like to note Brent Toderian is our keynote speaker at Inspire Burlington on February 11th. I invite you to join us for an engaging evening around great city-building.

Brent Toderian writes: “What really matters is how you grow big, not how big you grow…. Most cities perceive growth to be a positive thing when done well, supporting such civic goals as improving affordability, enhancing ecological sustainability, supporting social equity and choice, and stimulating creativity and economic development.”

We are improving conversations about density and we will continue to connect and engage with the community soliciting input on how we grow.

Extreme Weather Resiliency

In order to grow within our urban boundary, we need to be assured that our infrastructure can handle the growth. Since the flood of 2014, the City of Burlington and Halton Region have stepped up our focus on storm water and wastewater management.

Flood presentation - 407 flooded

The initial damage from the flood and the cost of making sure we don’t get hit as hard next time – Mayor said we need to plan for the next one

As a result of the thorough analysis and extensive reports completed by the City and Region, we have committed a total of more than $120 million over the next 10 years to improve our resiliency in the event of extreme weather.

A City That Moves

A City That Moves is where people and goods move through the city more efficiently and safely.

A City That Moves offers a variety of convenient, affordable and green forms of transportation that align with regional travel patterns. This is a city that features walkability within new and transitioning neighbourhoods, as well as in our downtown.

We are investing $300 million over the next 10 years on our roads, which includes such projects as road reconstruction, resurfacing and intersection widening.

However, moving forward, we are shifting our focus on moving people through more sustainable modes of travel that do not rely exclusively on the automobile.

Ninety per cent of all trips made on a weekday within our city – which number more than 260,000 – are made by automobile. Furthermore, 50 per cent of these trips are five kilometres or less.

Walkable trips are considered to be two kilometres or less. Bikeable trips are considered to be within the two to five kilometre range.

These are the ideal distances to cycle, walk or hop on a Burlington Transit bus – including to and from one of our three GO Stations.

Just ask Councillor Jack Dennison, who is on the cycling committee and can be found cycling to events on weekends.

Long-term, we are looking to implement a complete streets vision. This vision will be part of an integrated plan that will see on- and off-road bike lanes, sidewalks, multi-use paths and trails and public transit well-connected and coordinated.

Complete Streets will make Burlington more walkable and bikeable, support investments in transit, foster social engagement and community pride, support the local economy and property values, and improve the livability and long‐term sustainability of our region. Burlington will be a better place to live and work, realizing long‐term savings from improved public health and safety, environmental stewardship, social mobility and transportation equity.

Speaking of transit, we are expecting full implementation of our transit intelligent transportation system within the next few months. This includes a website, trip planning function, real-time information and stop announcements.

Creating walkable neighbourhoods directly relates to a City that Moves and a City That Grows.

Noted American urban planner Jeff Speck notes that a walk has to satisfy four main conditions: it must be useful, safe, comfortable and interesting.

When I ask people what they like most about living downtown, they respond it is they can walk everywhere. That is one of the reasons Councillor Marianne Meed Ward says she enjoys living downtown.

Just as Councillor Meed Ward walks to work every day, we want to develop more neighbourhoods across the city where people have that same opportunity.

Mobility hubs offer significant potential for intensification and walkability.

These are places of connectivity where different modes of transportation – from walking to commuter rail – come together seamlessly.

There are currently 3,500 customers using the Burlington GO station on a weekday. The addition of more than 900 residential units further transforms the site into a walk-friendly, cycle-friendly, transit-friendly neighbourhood that also includes office and retail. GO customers can look forward to 15-minute service on an electrified Lakeshore West GO line within the next decade.

This type of development also gives first-time homebuyers, especially young professionals, a chance to enter the real estate market, as well as those looking to downsize, units at a good price.

A Healthy and Greener City

A Healthy and Greener City is one in which the City of Burlington is a leader in the stewardship of the environment while encouraging healthy lifestyles.

In this area, I believe we are ahead of other municipalities with our Community Energy Plan, as well as our vast array of parks, recreation facilities and programming.

According to the respondents of our online survey about the draft Strategic Plan, a Healthy and Greener City was ranked as the most important of the four key directions.

Our health is one of our greatest assets.

Last week, NASA confirmed 2015 was Earth’s warmest year since record-keeping began in 1880. While last saw a major El Niño weather system, this dubious milestone was largely driven by climate change. Fifteen of the top 16 warmest years have occurred since the year 2000.

Healthy Lifestyles

Going back to Brent Toderian’s comments, the potential advantage of creating more density is making walking, biking and transit more appealing, which fosters improved public health.

Healthy living in Burlington is supported by a well-planned city with walkable neighbourhoods featuring good access to parks and recreation facilities.

The Mayor calls this the

Hundreds walk this park right out to the canal boundary every day.

We will ensure every resident lives within a short distance of parks or recreational spaces, creating multi-use parks and green space, and supporting the Bruce Trail. The city’s approximate 50-50 split between rural and urban settings has positioned us as a city rich in outdoor recreational space.

Good programming at top-level recreational facilities also promotes healthy living. Last January, for example, we opened a revitalized Mountainside Recreation Centre, which features an arena, outdoor pool and community space. This centre has become a draw for young people at the weekly No Socks for Ivan drop-in, with an upwards of 200 youth and teens coming weekly.

Councillor John Taylor was a staunch advocate in the revitalization of this recreation centre, and I know the community is grateful for his role in its transformation.

Late last year, City Council also approved a rebuild of Nelson Pool at a cost of approximately $5 million. The updated facility is scheduled to open in 2018, possibly earlier if construction goes well.

Related to a Healthy City and An Engaging City, a new initiative created by the City of Burlington that I am particularly excited about this winter is the neighbourhood rink program. Sixteen parks will feature 18 neighbourhood rinks for the 2015-16 winter season. This supports our parks and recreation mantra: Live and Play Every Day.

The rink program was inspired by Seattle community builder Jim Diers, who worked with our staff on neighbourhood power.

Inspired by Jim’s work, City Council approved $80,000 for community investment. This funding will support residents and groups of neighbours in enhancing city space by adding a park feature, creating an event or starting a new program.

Burlington is also one of 45 communities across Ontario taking part in the Healthy Kids Community Challenge. The City will receive up to $1.1 million in one-time funding from the Province between April 2015 to March 2018 to promote children’s health through physical activity and healthy eating.

Healthy living is also connected to good community health care. The City of Burlington has committed $60 million to the redevelopment and expansion of Joseph Brant Hospital. This is the city’s largest investment in a non-city facility in the history of our community.

Groundbreaking took place in March 2015 for the redevelopment and expansion project’s second phase: a new seven-storey patient care tower.

When construction of the tower is complete in 2017 Joseph Brant Hospital will feature 172 acute inpatient beds, a new emergency department, a larger cancer clinic, nine new operating rooms, expanded medical, surgical and outpatient services, and much more.

Brant hospital - part of 4th floor

Joseph Brant Hospital getting close to topping off. Will open in 2018

Joseph Brant Hospital treats more than 250,000 patients each year. The hospital opened in 1961, but has not had a major renovation since 1971.

I want to thank the provincial government for their significant investment that will cover approximately two-thirds of the total cost of the project.

The Joseph Brant Hospital Foundation is close to reaching its $60 million contribution. To date, the foundation has raised $48 million thanks, in part, to significant donations in 2015 from the Joyce Foundation, Voortman Cookies (Mr. Harry Voortman) and Longo’s Family Charitable Foundation.

A healthy and greener city encourages sustainable projects. Our community gardens program has been well received by the community and we are looking to continue to grow it.

Burlington City Council appreciates Halton Regional Council’s support of the Burlington Beach Regional Waterfront Park Master Plan. The development of this park will enhance the Region of Halton. The park features a natural sand beach that is part of a unique landform called a Baymouth Bar. It is also home to provincially and regionally rare plant and animal species.

The estimated project cost is more than $51 million. The majority of the Burlington Beach Regional Waterfront Park plan will be developed over the next five to ten years. It could take up to twenty to twenty-five years to completely finish the park.

Environmental Leadership

The ongoing implementation and updates of the Community Energy Plan are integral to moving forward as a city on environmental leadership.

This past year, we had a number of accomplishments connected to our Community Energy Plan: Burlington Hydro’s co-gen pilot project, our first electric vehicle charging station on city property and my Inspire Burlington Series/Take Action Burlington event with David Miller from the World Wildlife Fund.

Carpentr House - walking the trail

Citizens walking the trail in the Beachway along what was once a railway line.

We are also in the process of completing phase one of our community energy system feasibility study. The study is looking at opportunities for more efficient and sustainable local generation of thermal energy with electrical generation.

Long-term, we are looking to continue moving forward on environmental leadership through a variety of initiatives, such as city operations that are carbon neutral, increasing our urban forest and tree canopy, and continuing to preserve our rural area.

We continue to be proud partners in the Cootes to Escarpment Eco-Park System. This is a collaboration between ten local government and non-profit organizations to protect, restore and connect more than 9,600 acres of natural lands at the western end of Lake Ontario.

David Suzuki said: “I can’t imagine anything more important than air, water, soil, energy and biodiversity. These are the things that keep us alive.”

An Engaging City

In a city that engages, community members are engaged, empowered, welcomed and well-served by their city. Culture and community activities thrive, creating a positive sense of place, inclusivity and community.

Our vision of an engaged city builds on the foundation we have laid since our Engagement Charter was approved by City Council in 2013.

We created and launched the Get Involved page (www.burlington.ca/getinvolved) for all things citizen engagement on the city’s new website. This includes our online platforms – Let’s Talk Burlington and Insight Burlington, Get Involved calendar and volunteer opportunities.

A rapt audience listened to an overview of the 2014 budget. What they have yet to have explained to them is the desperate situation the city will be in ten years from now if something isn't done in the next few years to figure out how we are going to pay for the maintenance of the roads we have.

A rapt audience listened to an overview of a city budget.

In the past year, we engaged thousands of residents online on a variety of topics, like the Transportation Master Plan, community gardens, Strategic Plan, budget, intensification and parking.

Councillor Paul Sharman’s engagement with the community around the potential redevelopment of Lakeside Plaza is commendable. Last November, more than 300 residents came out to the Lakeside Plaza visioning exercise.

Budget

It goes without saying that a major priority for council and staff is balancing increased services and investments with the need for responsible tax rate increases.

The capital budget was approved in December and the operating budget for 2016 was approved this week.

When combined with the Halton Region and the school boards, the overall property tax increase is 2 per cent and that number is inclusive of a 3.14 per cent increase in the city’s portion.

The city increase of 3.14 per cent is broken down as follows:

The base budget increase of 1.28 per cent that is less than the Consumer Price Index.
A 1.44 per cent increase dedicated to the renewal of the city’s infrastructure.
42 per cent to increase service levels in areas such as winter maintenance, bylaw enforcement and storm water management.

The 2016 budget marks the second year the city presented the operating budget in a service based format. Under this approach, business plans are developed for all 37 of the services provided by the city.

We will continue to strive towards annual property tax increases that are responsible to current and future residents, as well as reflect inflationary increases, infrastructure renewal and increased service investments.

Government Partnerships

Building strong relationships with other governments also moves us towards our goals as a city.

Federal infrastructure investment, which we support 100 per cent, is a key priority of the new Trudeau government.

Property taxes in Ontario are the highest in the country, so we also welcome the federal investment in identified priorities around affordable housing, public transit and climate change.

I look forward to working with our Members of Parliament Karina Gould, Pam Damoff and Lisa Raitt on these issues.

Recognizing that municipalities are a provincial responsibility, it is only natural I have regular contact with our Members of Provincial Parliament Eleanor McMahon and Indira Naidoo-Harris on a wide range of issues, including transit and transportation, environment and municipal legislation.

Meanwhile, the cities of Burlington and Hamilton are involved in discussions through our city managers. The two mayors and members of council also meet as the Greater Bay Area Subcommittee to discuss areas of common interest.

It is noteworthy that Burlington and Hamilton’s chambers of commerce are hosting the second annual Bay Area Economic Summit in June.

This term, I have also played a leading role at the Association of Municipalities of Ontario. I currently serve as the Chair of the Large Urban Caucus and the Chair of the Climate Change Task Force. I am also on the Memorandum of Understanding team, which meets regularly with the Minister of Municipal Affairs and Housing and other members of provincial cabinet discussing proposed changes to policy and legislation affecting municipalities.

Public Engagement Through Cultural and Community Activities

As the City of Burlington grows and will continue to do so over the coming decades, we are diversifying. It is essential to foster a Burlington where everyone feels welcome, regardless of age, race, gender or sexual orientation.

Councillor Blair Lancaster represents one of our most culturally diverse wards. She is focused on creating a strong sense of belonging in neighbourhoods in her ward, as well as city-wide through her role on the inclusivity advisory committee.

The ongoing initiative of Burlington groups sponsoring Syrian refugees and the outpouring of support is an example of the embodiment of engagement and inclusivity.

Arts and Culture

Thanks to city investment and the dedication of leaders, boards, staff, and members of the arts and culture community, I believe we are starting to fully realize the tremendous assets we have right here in our city.

The Burlington Performing Arts Centre was booked for more than 600 uses last year, with in excess of 100,000 visitors. Based on the recent economic impact study in 2014, the arts centre generates $7.8 million in annual economic activity, with room to grow. It also serves as a world-class venue for many local groups, from our Burlington Teen Tour Band and Symphony on the Bay to Tottering Biped Theatre and Burlington Student Theatre. Suzanne Haines became the centre’s new executive director last year.

The Art Gallery of Burlington saw another good year, with new leadership from Robert Steven as the president and CEO. There were 45,000 visitors to exhibitions, not including visitors from facility rentals. There were also 24 exhibitions in their five gallery spaces in 2015.

Ireland Hse front view

Ireland House – heritage that was saved.

Last year, Burlington Museums connected with a large number of young people, in particular, through its education programming. Almost 5,000 children visited the museums through camps, and school and youth group education programs.

More than 1.1 million people visited Burlington Public Library’s seven branches in 2015. The library loaned out nearly 2 million items last year – the equivalent of each resident in Burlington borrowing 10 to 11 items.

Last year marked a historic moment for the City of Burlington’s Public Art Program when six murals were unveiled by seven local artists at one time in December 2015.

There are also the numerous festivals and events that showcase our city and boost our local economy. Hundreds of thousands of people come from near and far to take in events like the Sound of Music Festival, Canada’s Largest Ribfest, the Children’s Festival and Canada Day.

Arts and culture has been a cornerstone of societies throughout history and they will continue to be so in Burlington as we look to the future. Canadian scientist Steven Pinker said: “There is no society ever discovered in the remotest corner of the world that has not had something that we would consider the arts.”

What do we want Burlington to be in twenty-five years?

We want to be a city that grows, a city that moves, a healthy and greener city and a city that engages.

Let’s work together to make our great city even greater.

State of the city addresses by Mayor Rick Goldring:

State of the City 2011
State of the City 2012
State of the City 2013
State of the city 2015

Return to the Front page

The old Beachway community that used to exist on either side of Lakeshore Road is getting a nifty upgrade with bike lanes and curbs and a stop light. Progress!

News 100 redBy Pepper Parr

January 27th, 2016

BURLINGTON, ON

The beginning of the new Beachway community will show its head when the city begins upgrading Lakeshore Road from Maple Avenue to the Waste Water Treatment plant.

Lakeshore Road upgradeWork on a road that will have two lanes, curbs, bike lanes and come in at a cost of $4,170,000 is expected t begin in July – the Regional government will pick up $1 million of the expense.

The rebuilding of the road is tied into the re-build/redevelopment of the Joseph Brant Hospital that is coming along very well – they expect to have poured the slab for the top floor by the end of the month – or very soon after. There will be a rolling closure of the road, expected to begin in July through to November.

The Region is installing a 300 mm water main replacement.

Laura Gillespie points out the part of the Beachway that affects her the most - the spot where her house is located.

Laura Gillespie points out the part of the Beachway that affects her the most – the spot where her house is located.  The upgrading of Lakeshore Road will not go as far as her house.  Her hope is that the house stays.

Lakeshore Road will be raised as much as three feet in that area directly in front of the Road where the hospital construction is taking place.

And there will be a traffic signal at the hospital parking garage – a sign that the Beachway is going through a real change

None of the homes the Region is very anxious to purchase will see the new road running in front of their door – the work on that part of Lakeshore Road is dependent on the recommendations of the Burlington Beach Regional Waterfront Master Plan.

Return to the Front page
